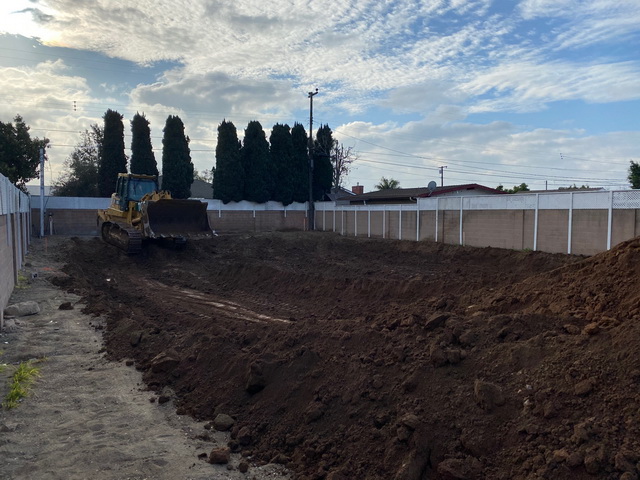

January 24, 2022 Grading begins

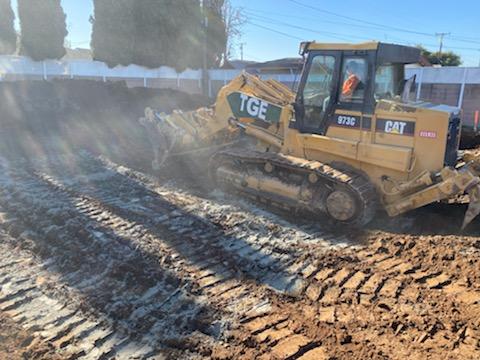

Moving dirt January 31, 2022

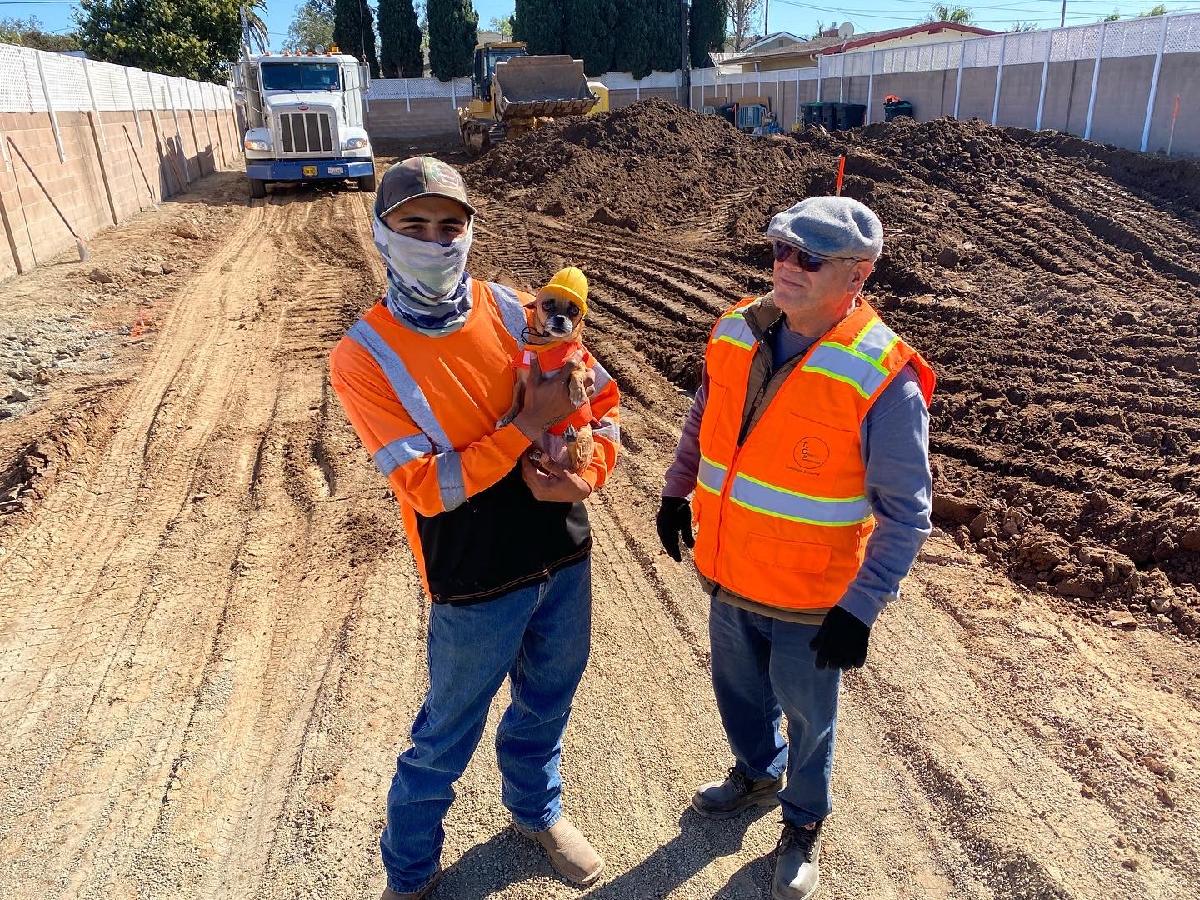

Bubbles helps Greenleaf...

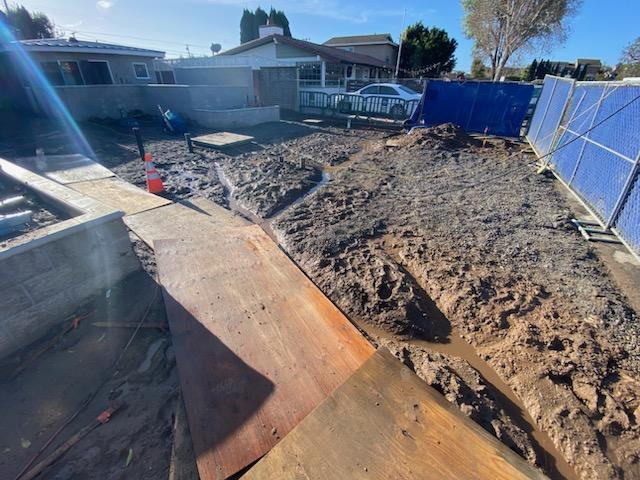

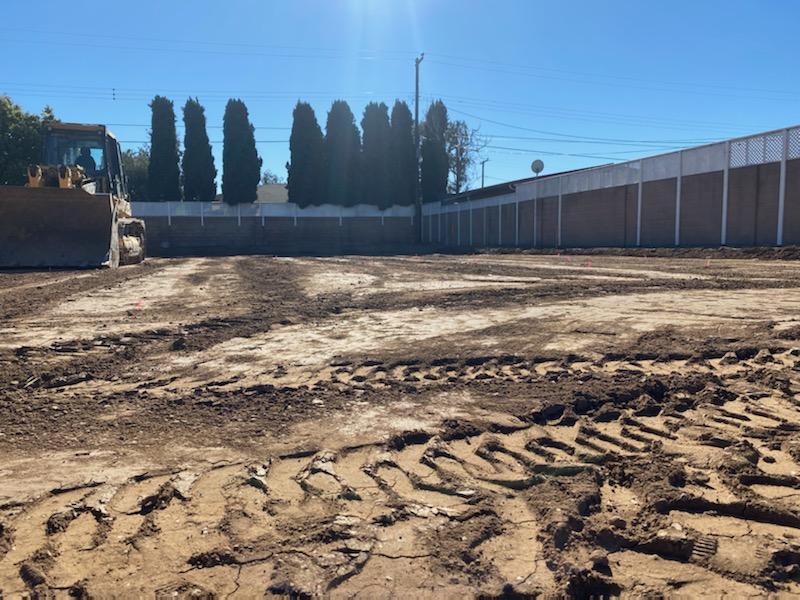

Flat earth! February 7, 2022

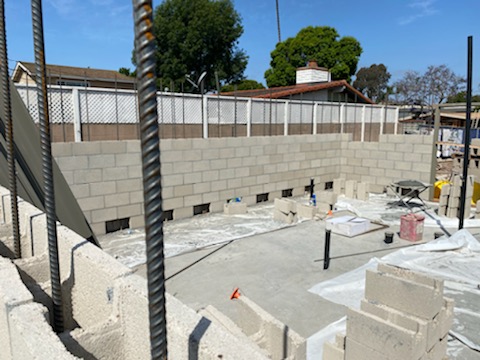

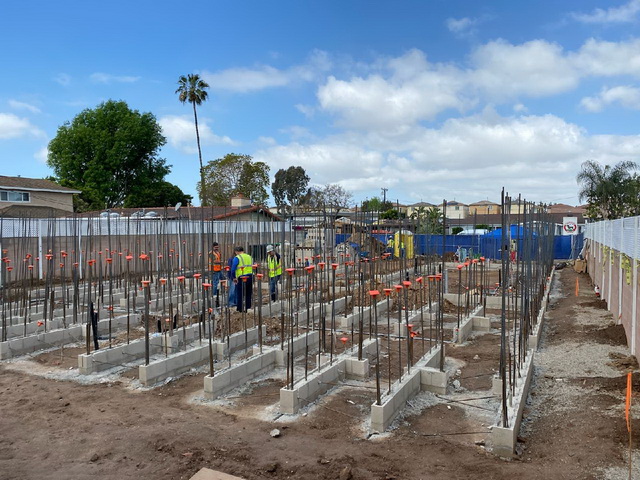

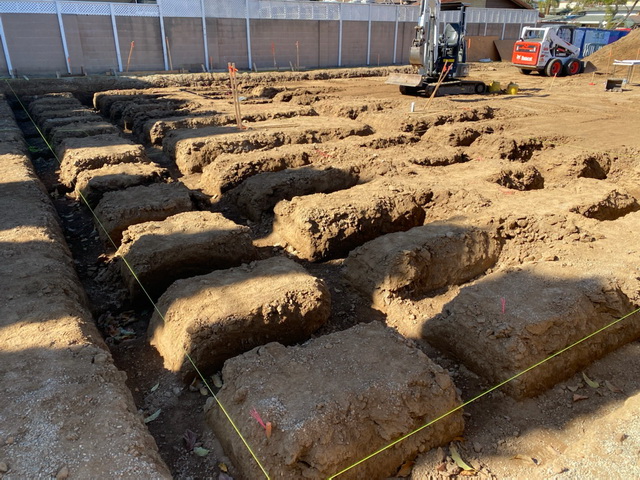

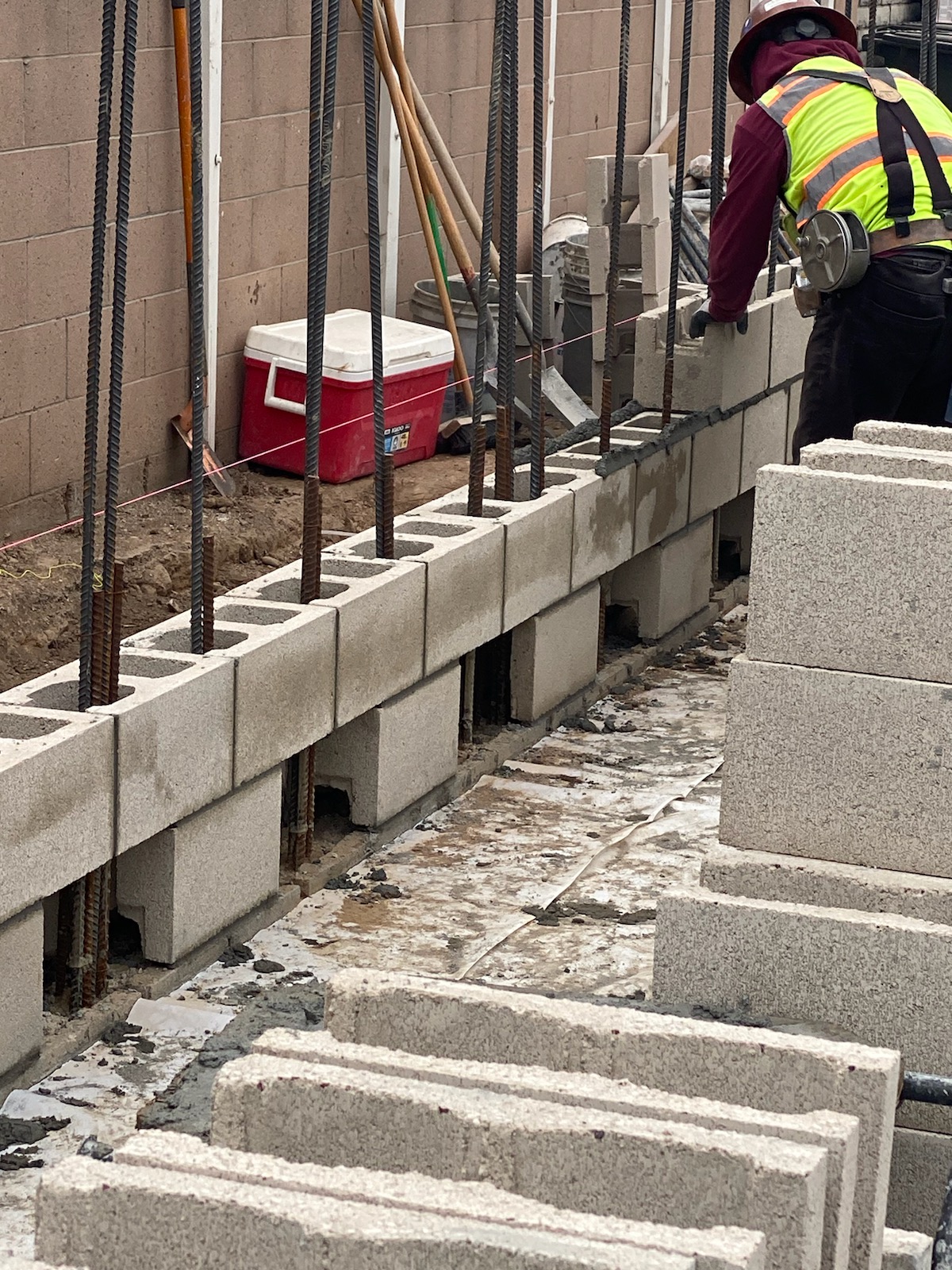

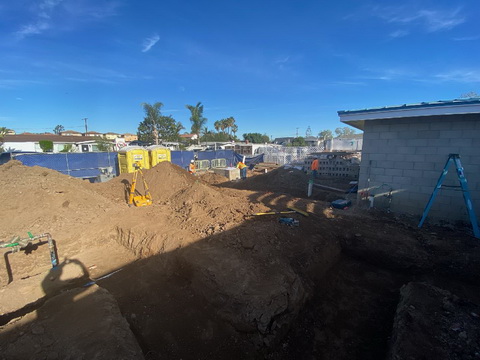

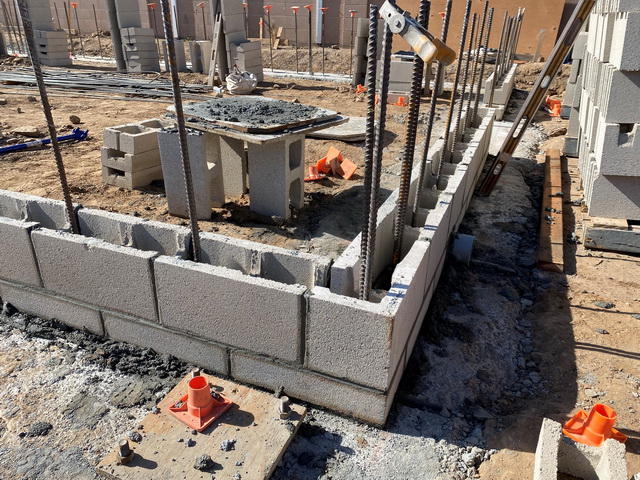

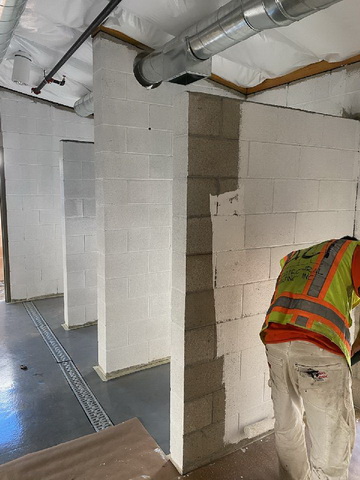

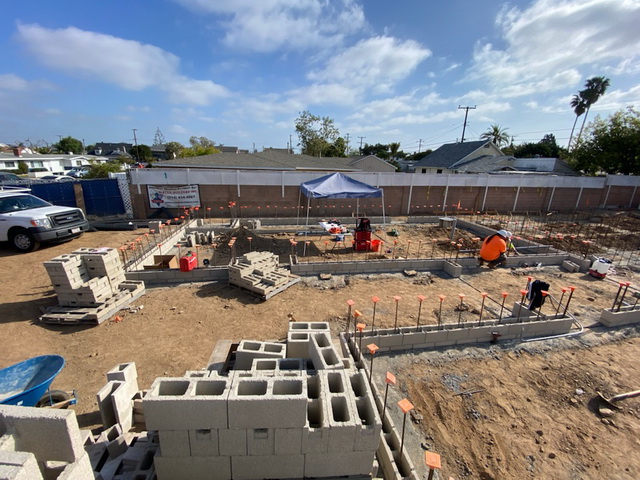

Kennel Footings February 16, 2022

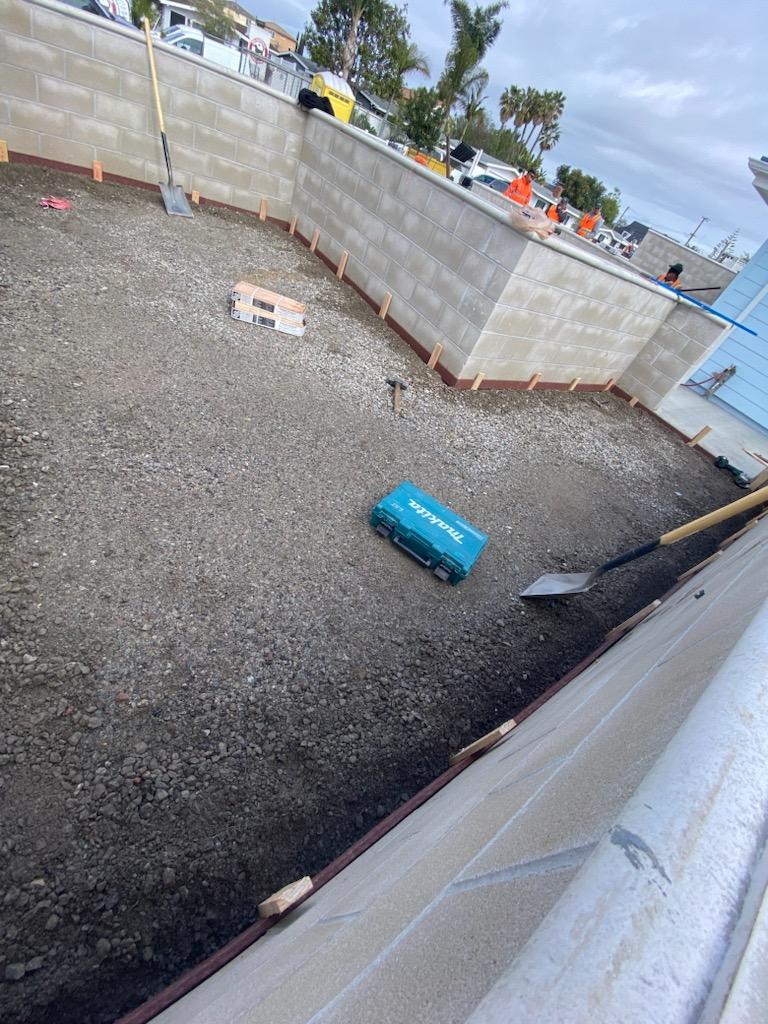

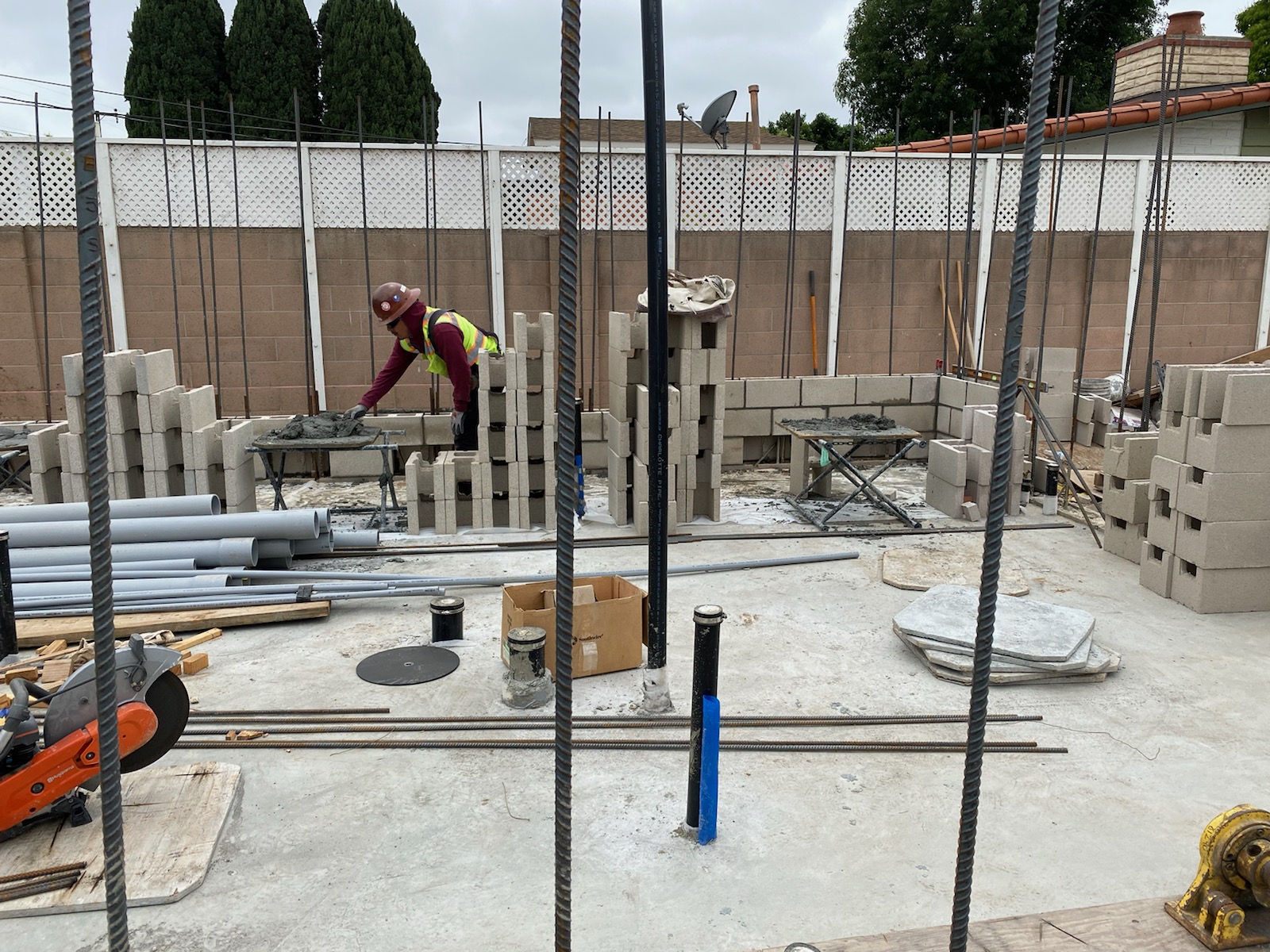

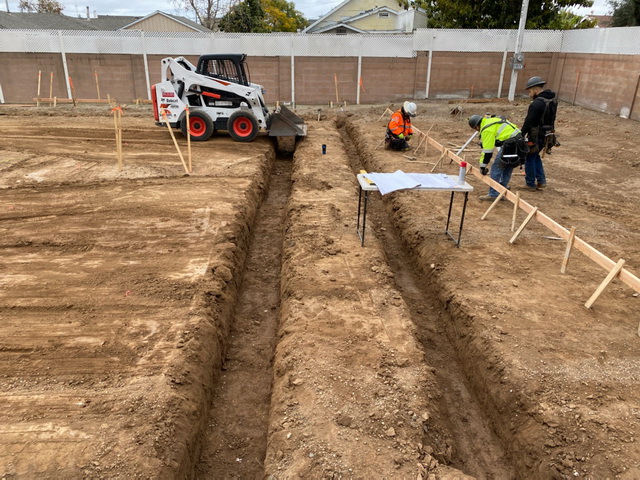

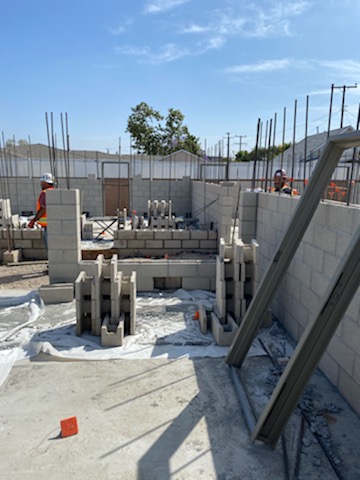

Center of the kennel February 16, 2022

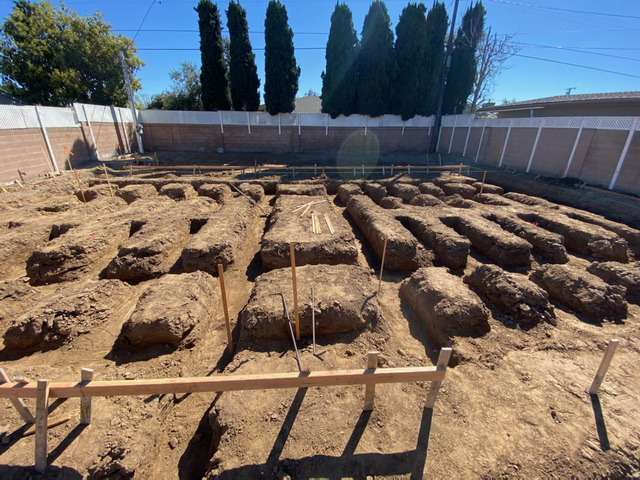

February 18, 2022

March 10, 2022

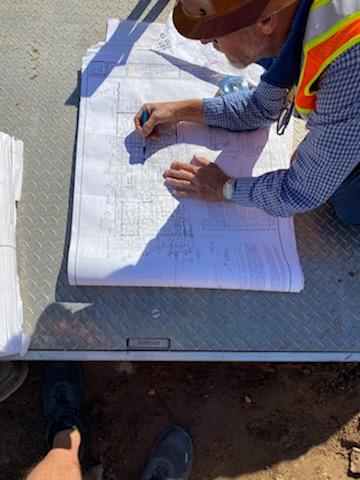

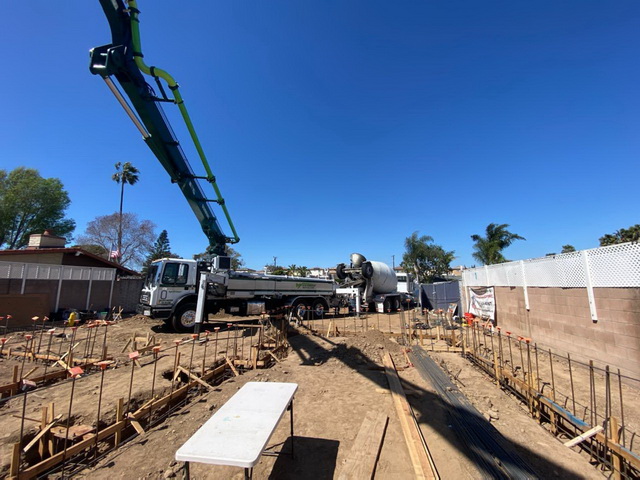

March 16, 2022

March 18, 2022

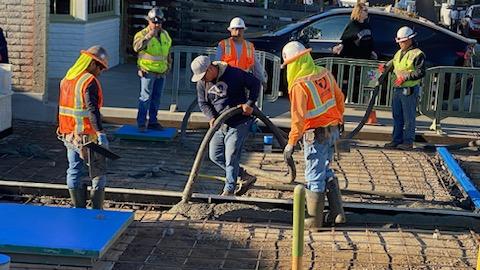

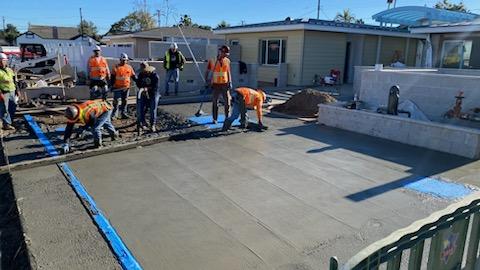

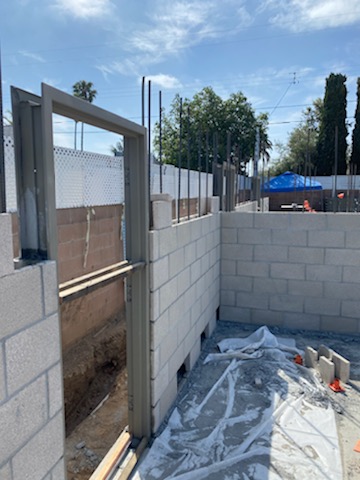

March 30, 2022

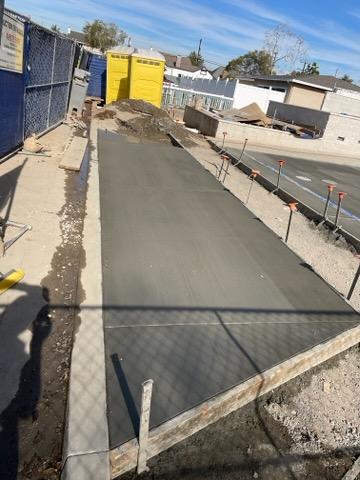

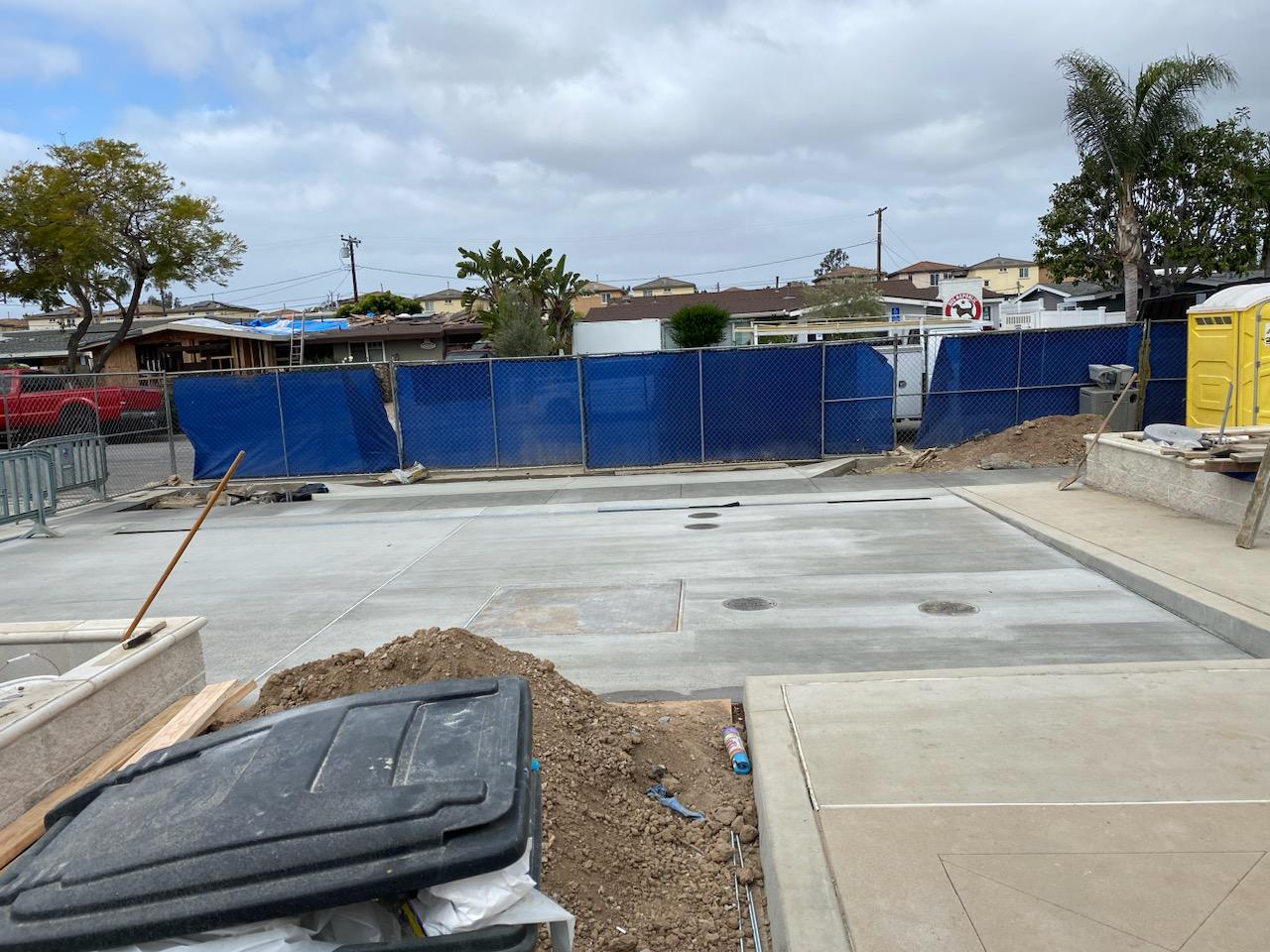

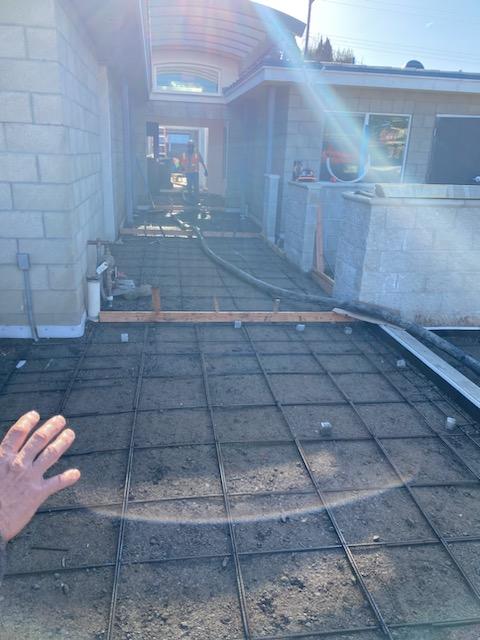

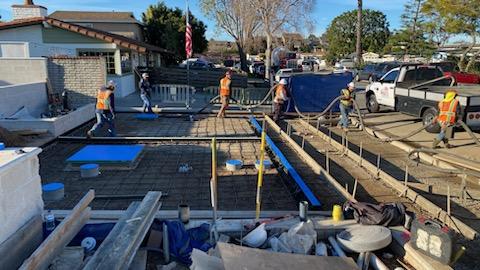

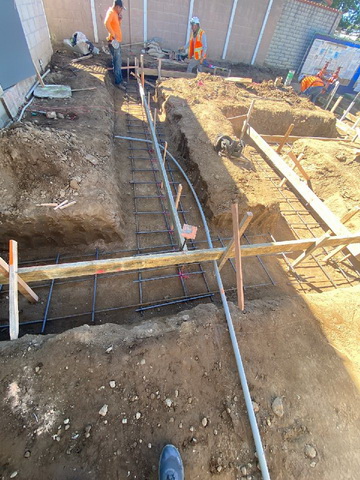

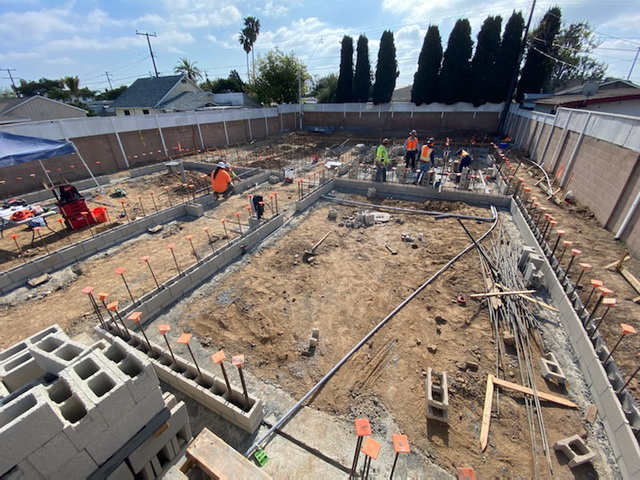

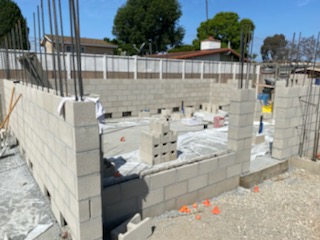

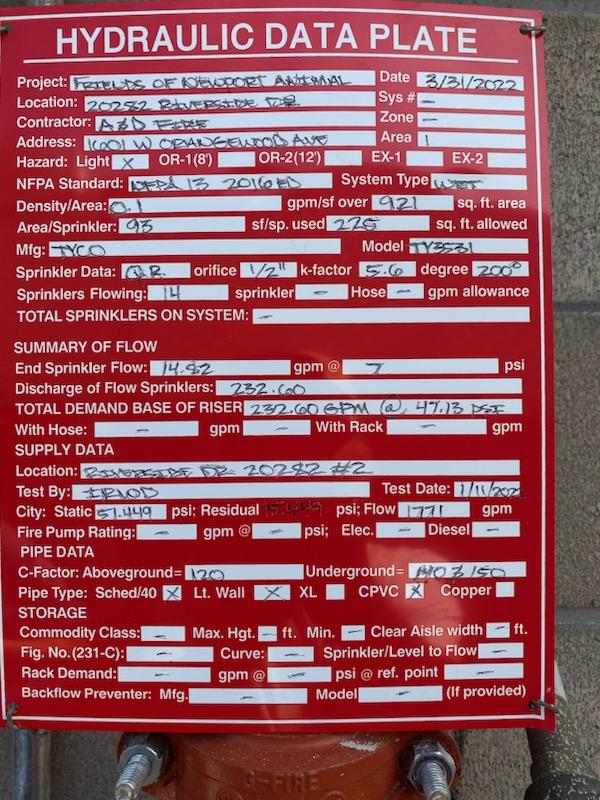

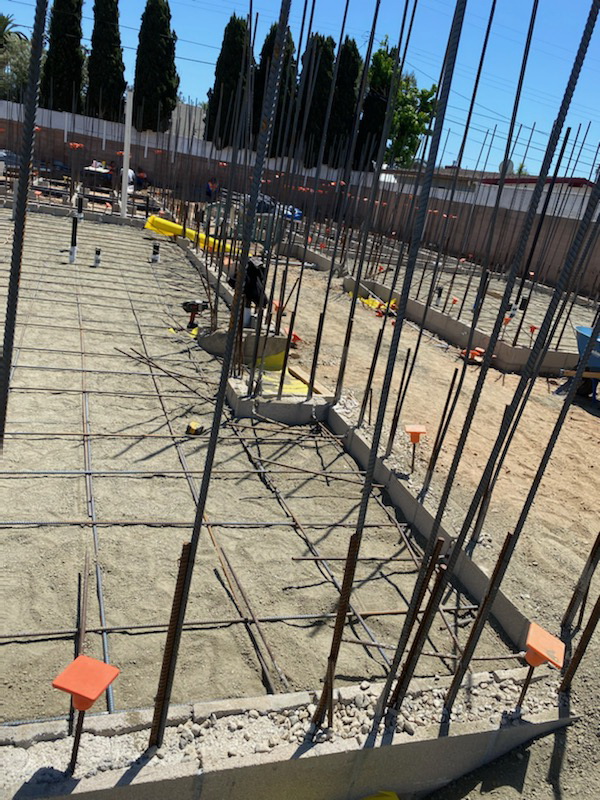

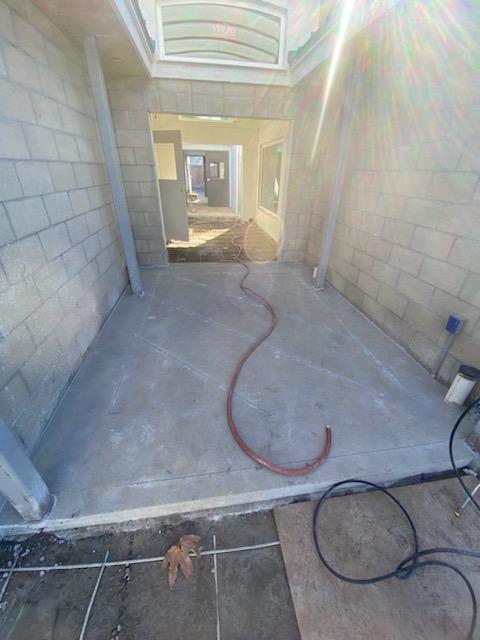

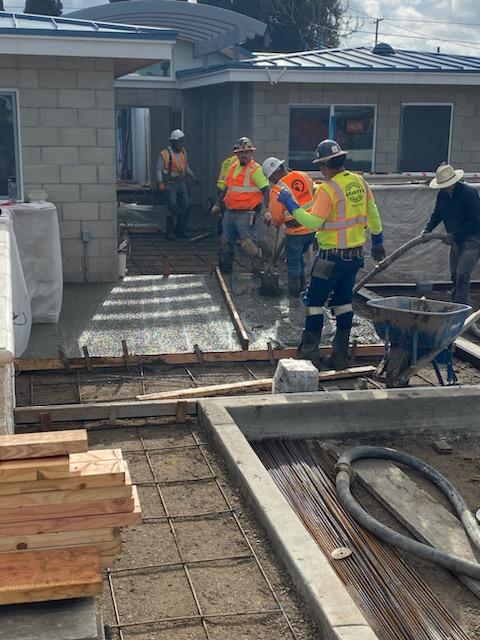

Ready for termite spray... inspection and concrete pour for main building slab.

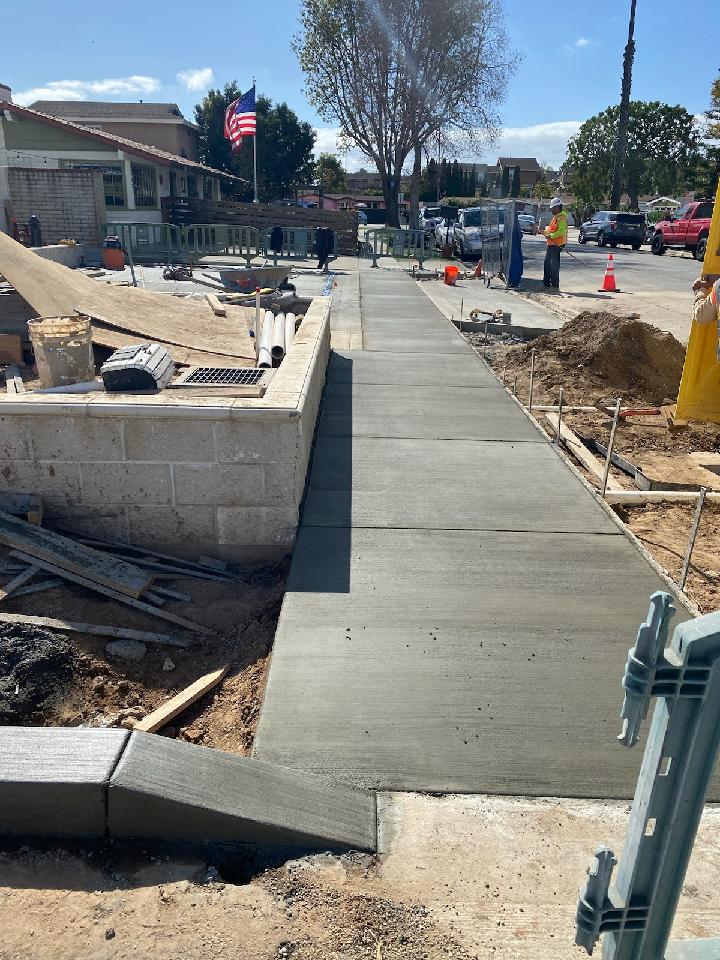

April 20, 2022

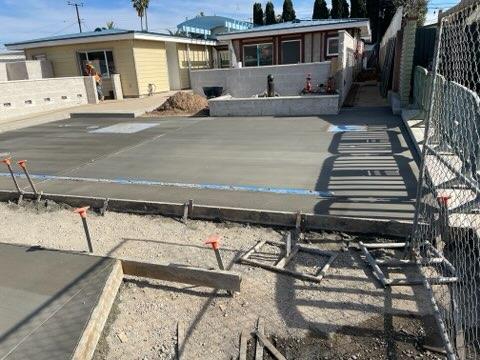

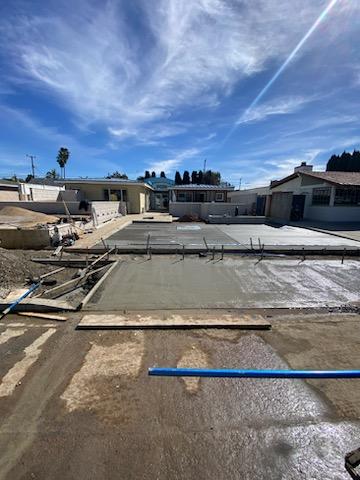

Foundation poured for main buildings

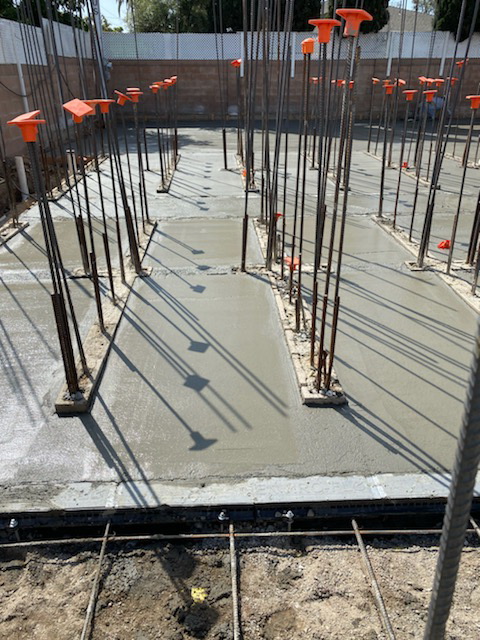

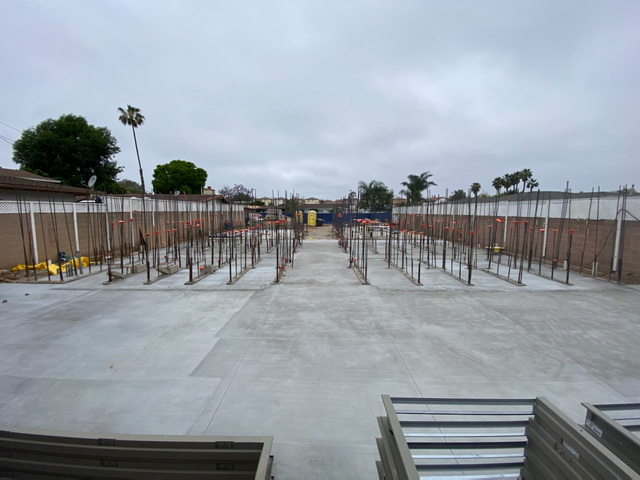

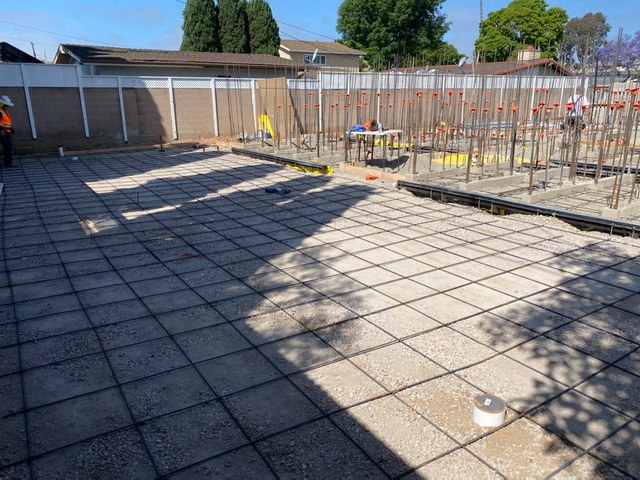

May 16, 2022

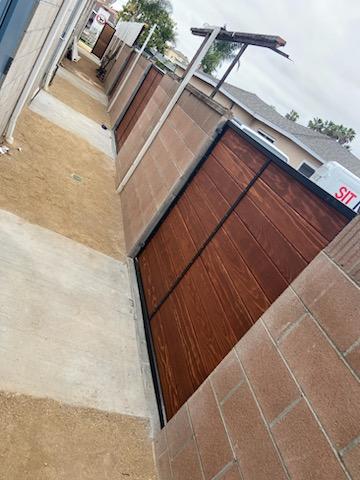

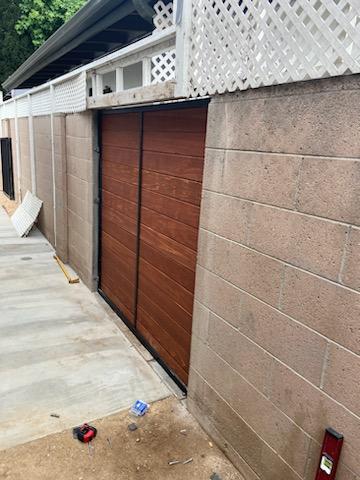

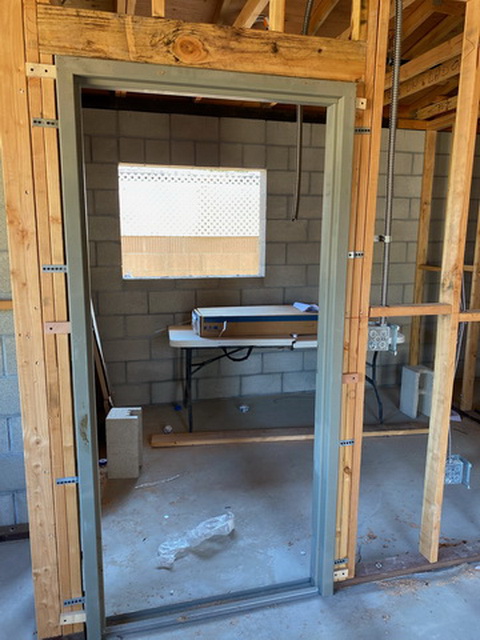

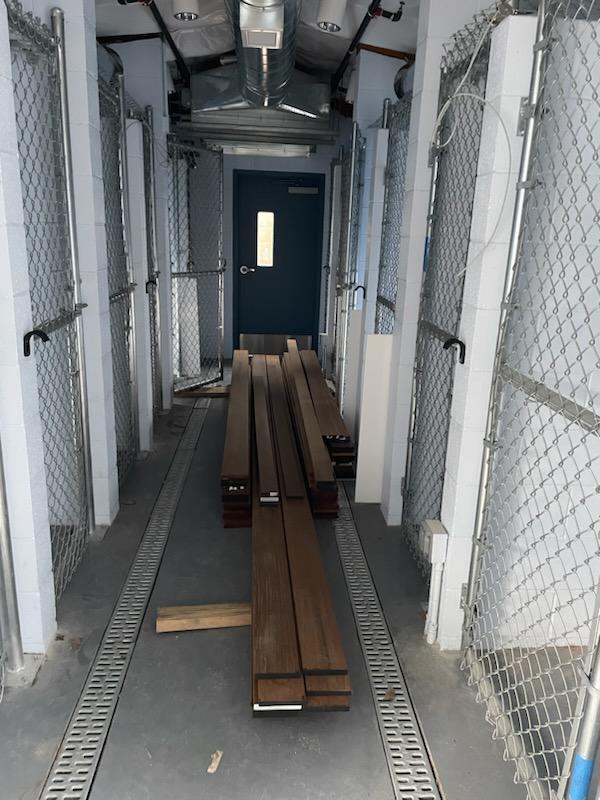

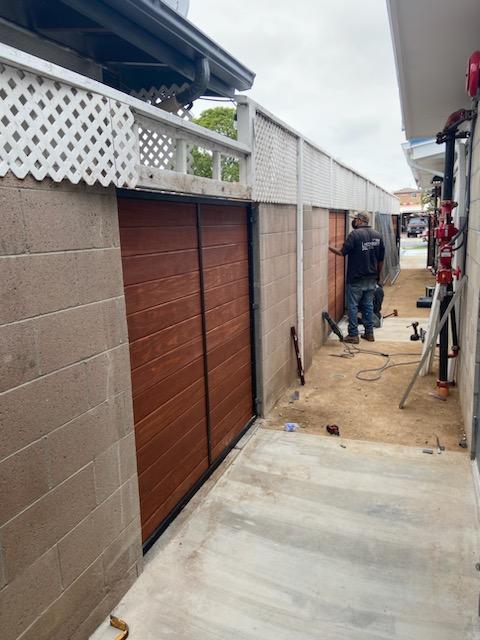

Door frames and concrete pad in backyard.

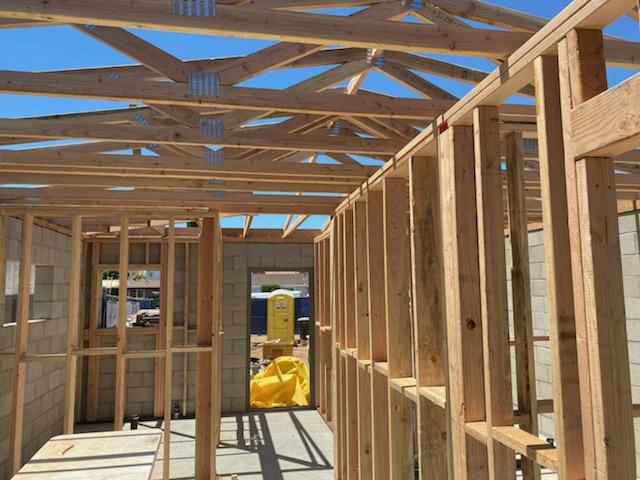

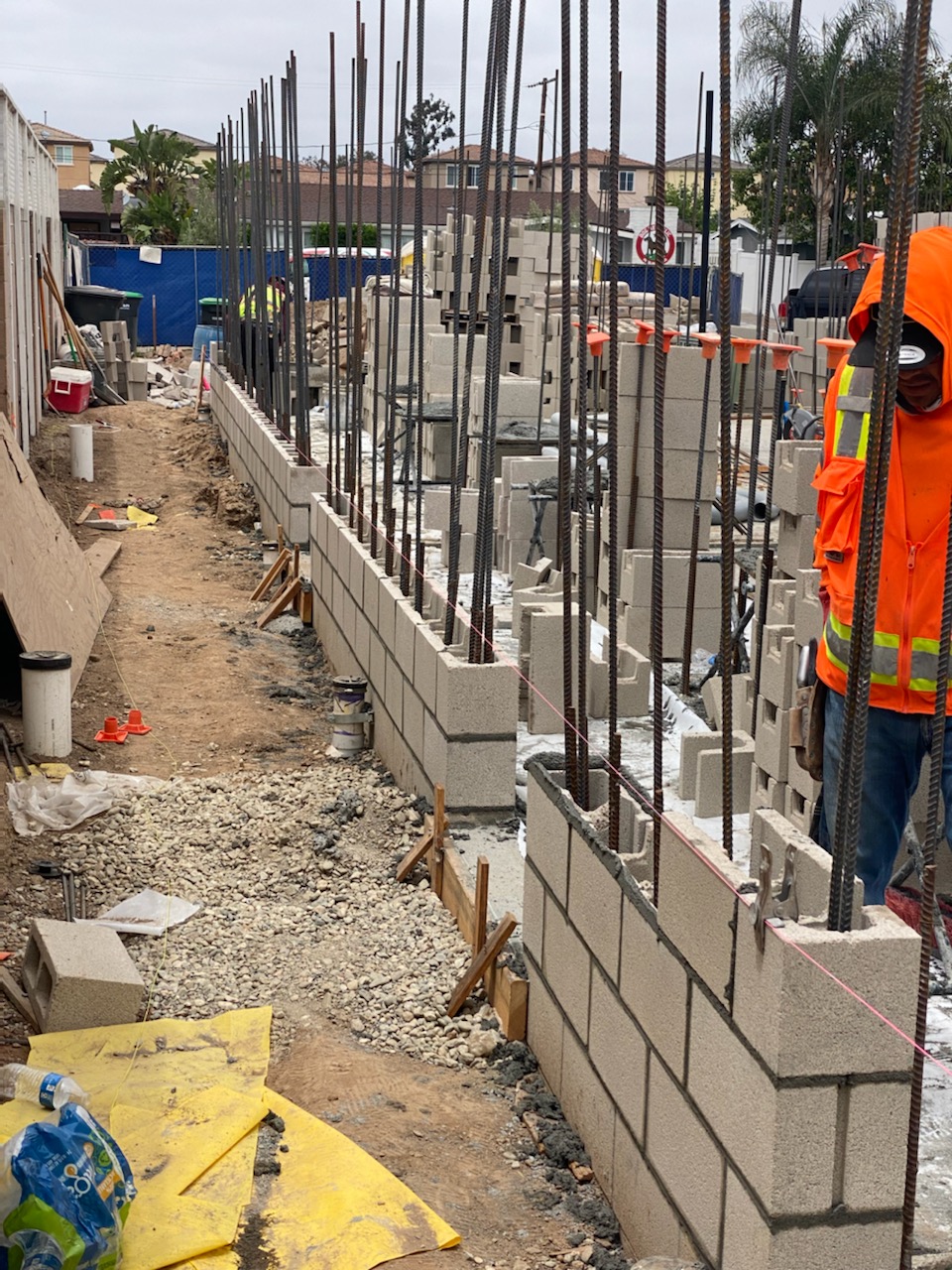

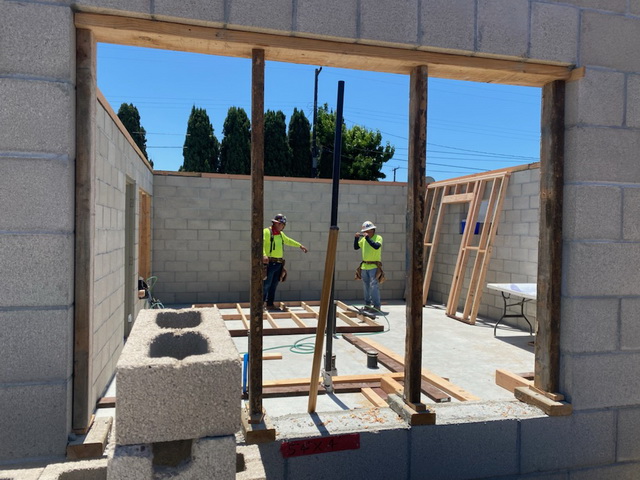

March 23, 2022 Walls beginning to go up!

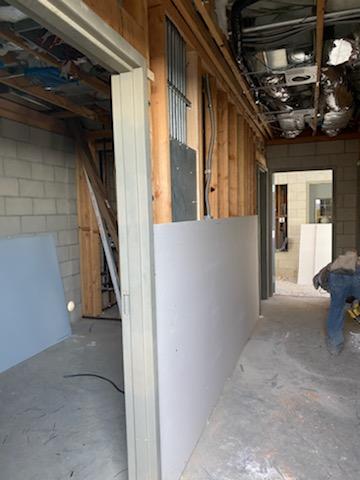

March 26, 2022 Fast progress on walls & doors

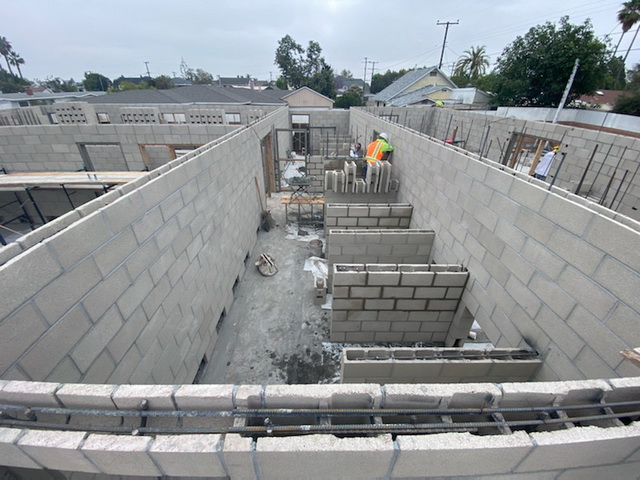

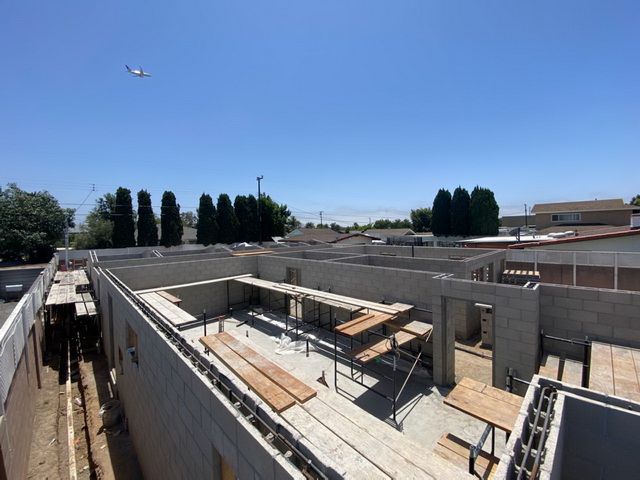

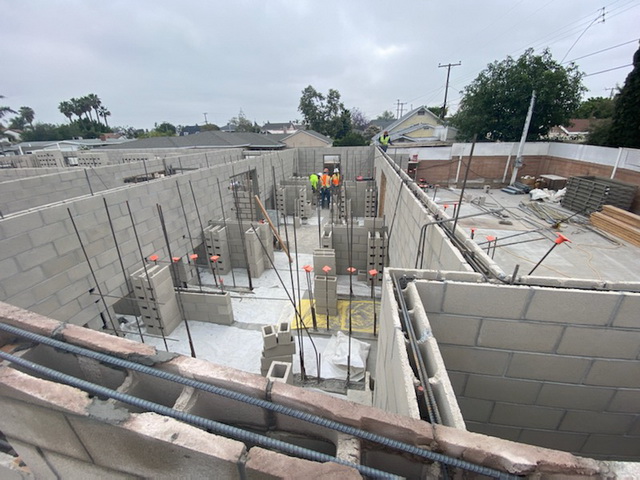

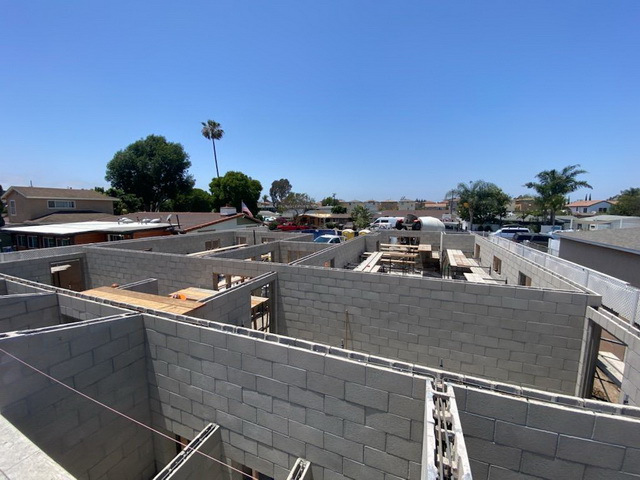

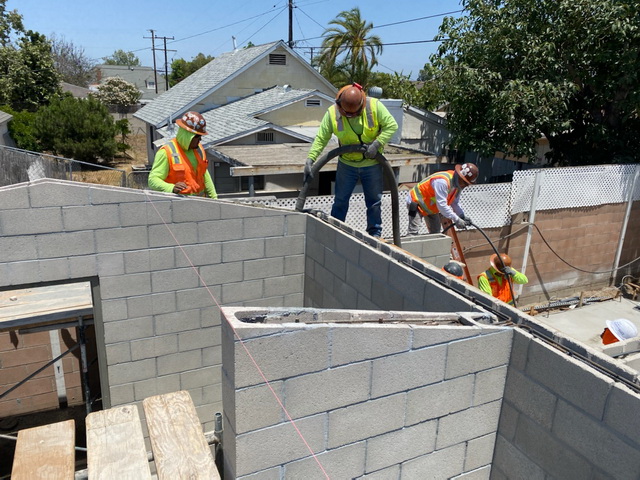

June 16. 2022 Progress as walls are finished.

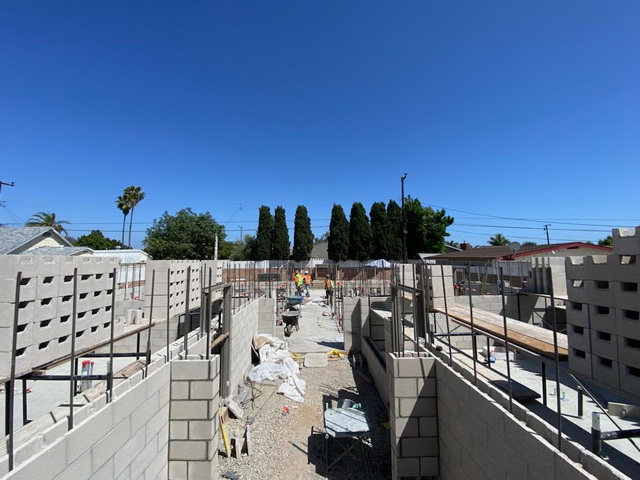

June 22-24, 2022 Framing goes up fast!

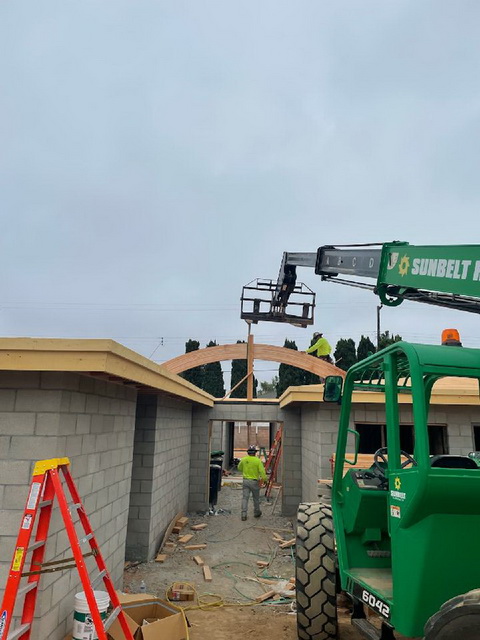

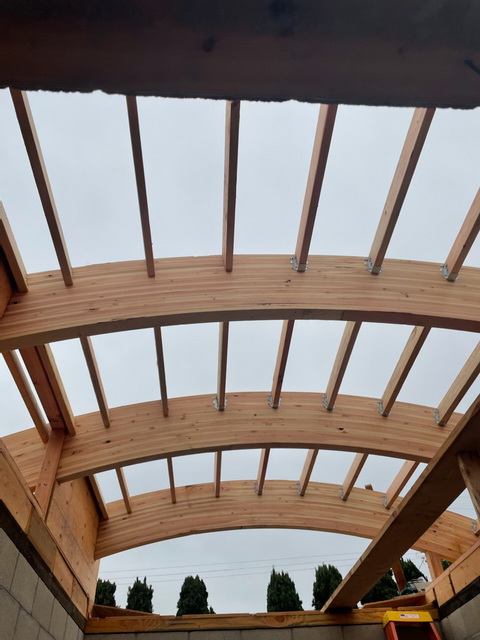

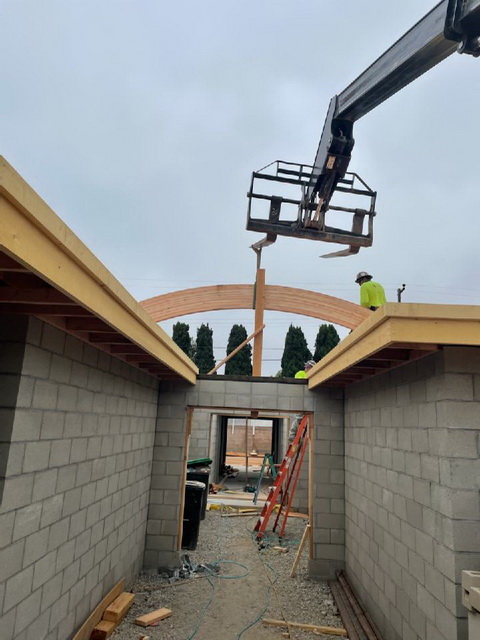

July 6, 2022 Topping out!

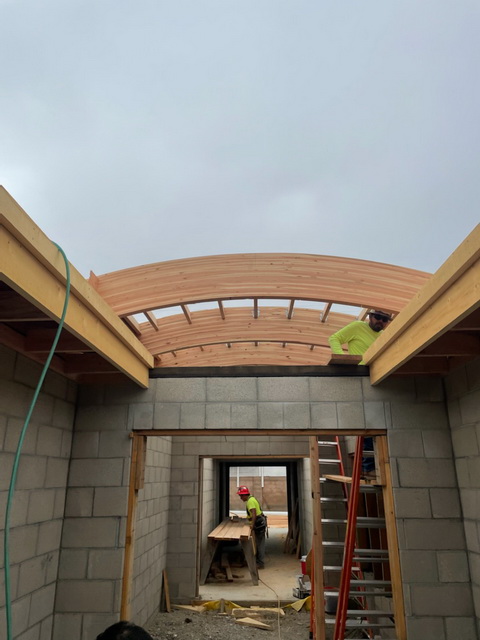

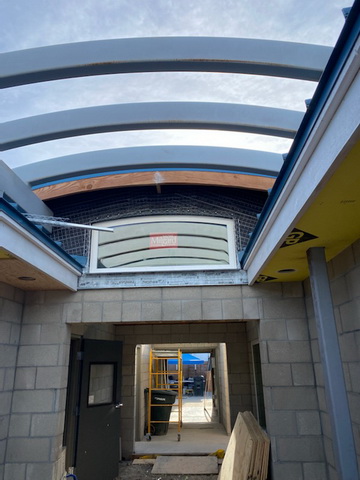

July 7, 2022 Trellis over the entry

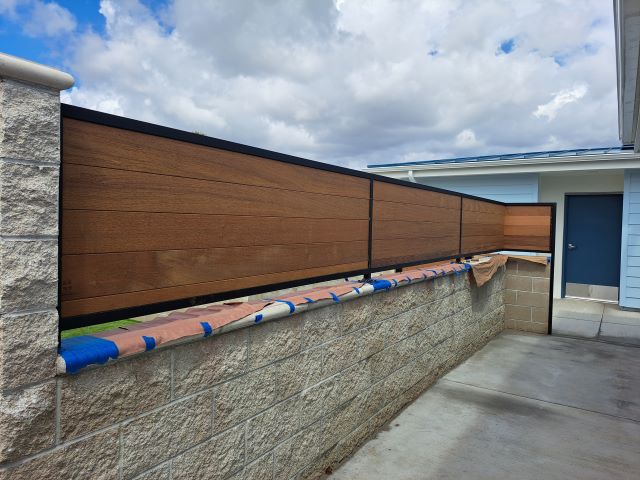

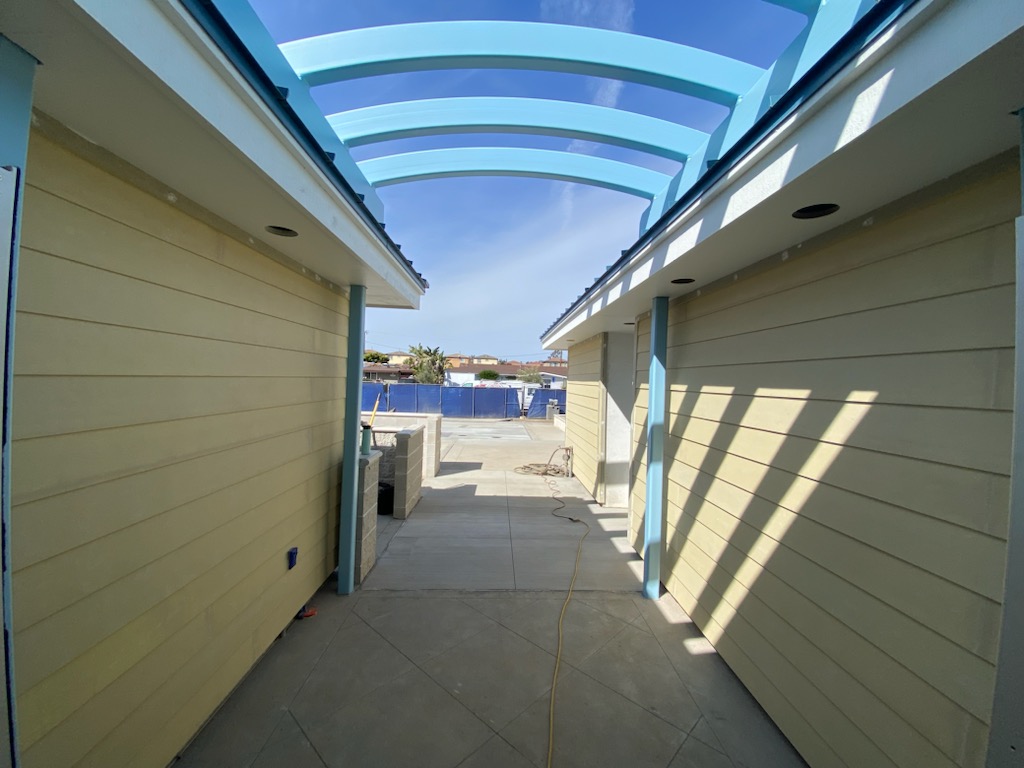

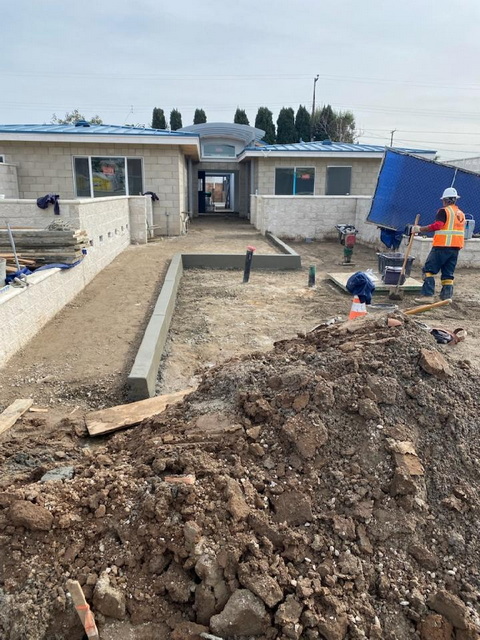

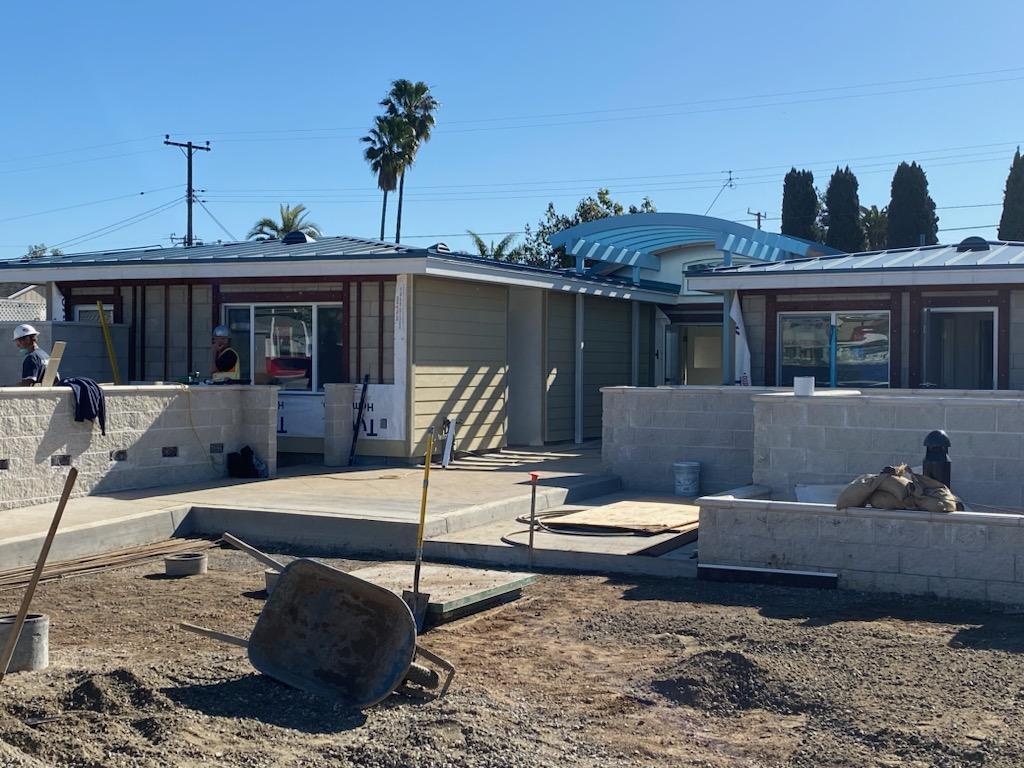

August 24, 2022

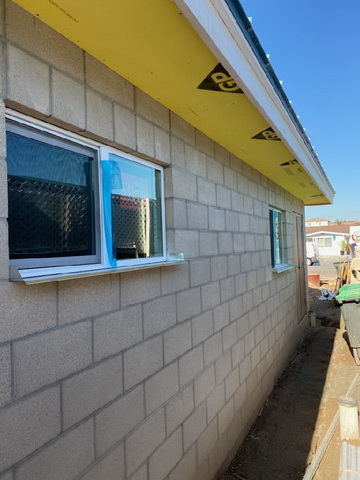

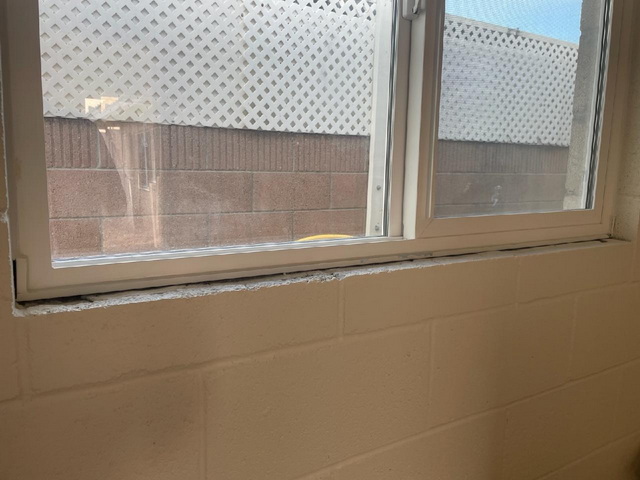

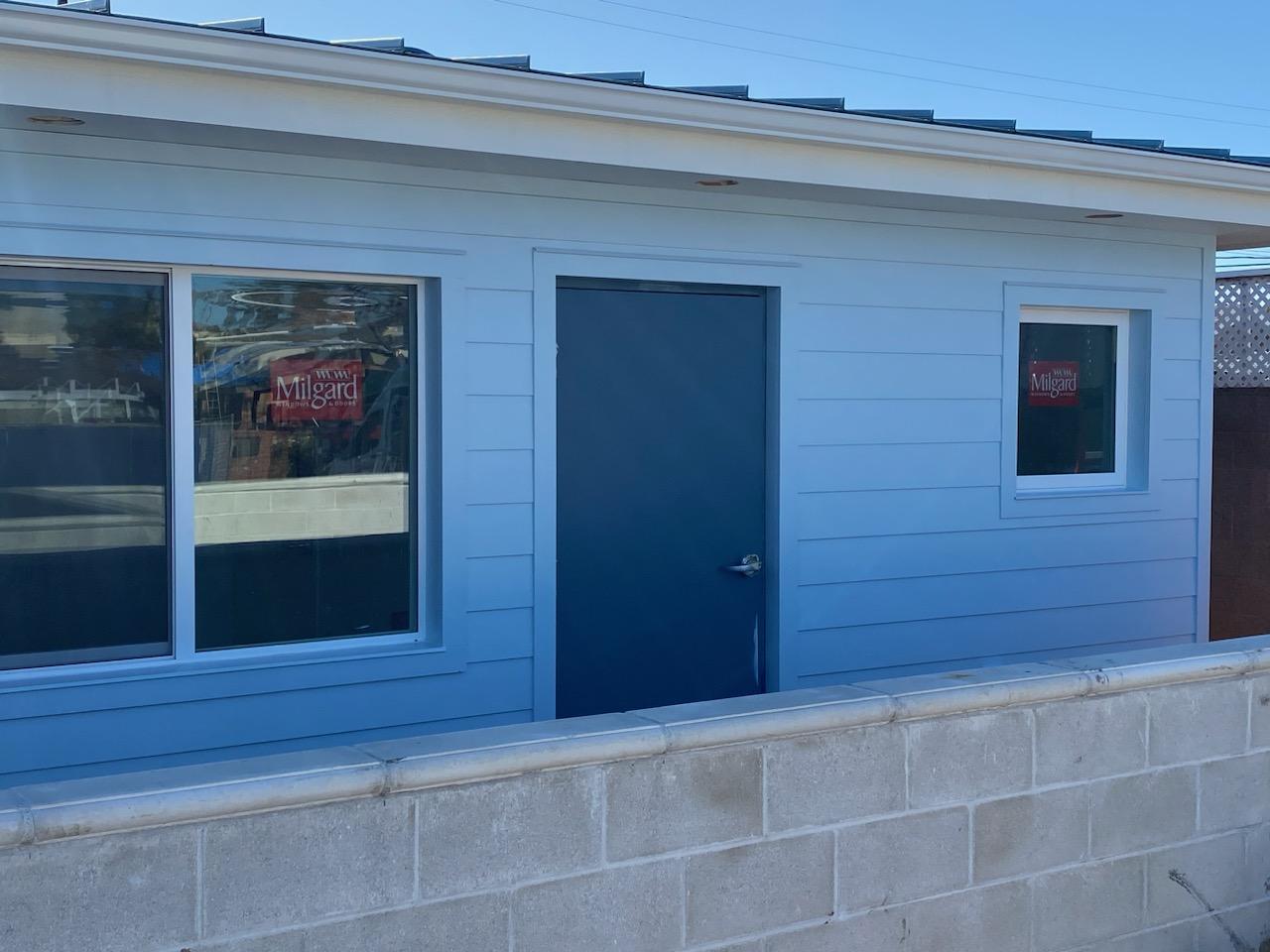

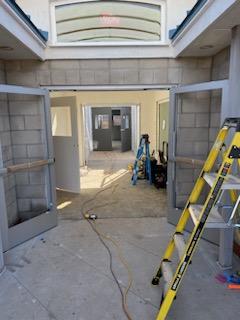

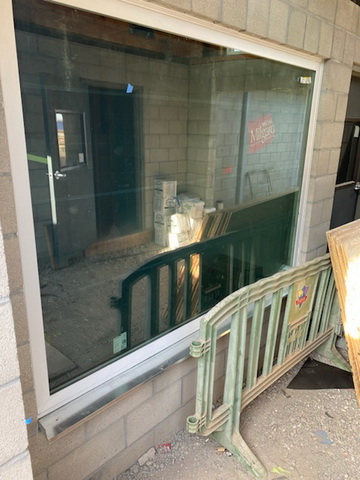

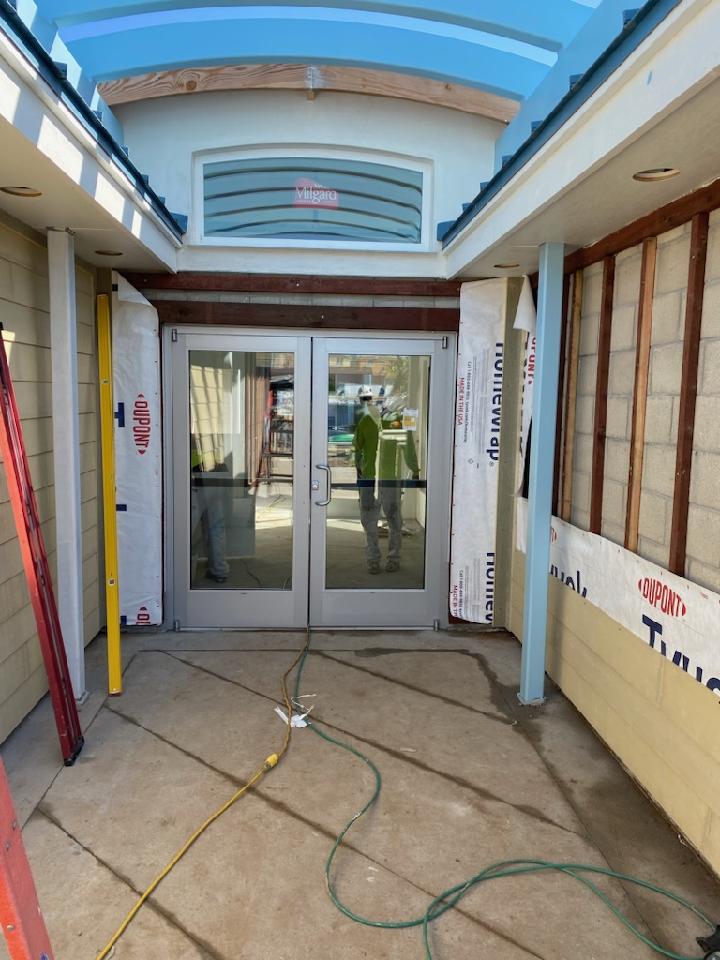

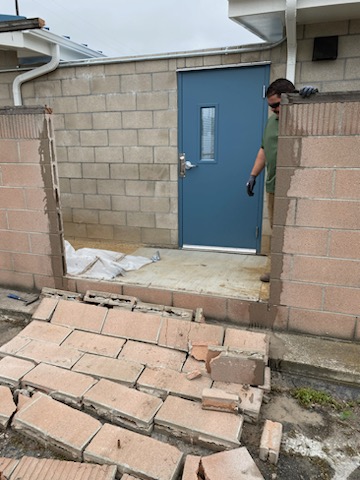

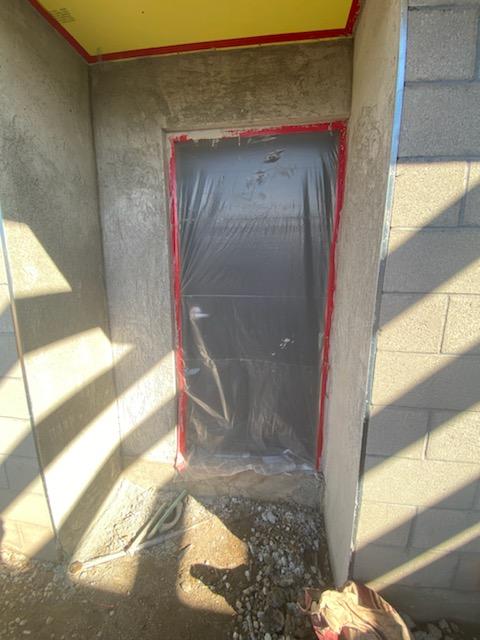

Doors and windows going in

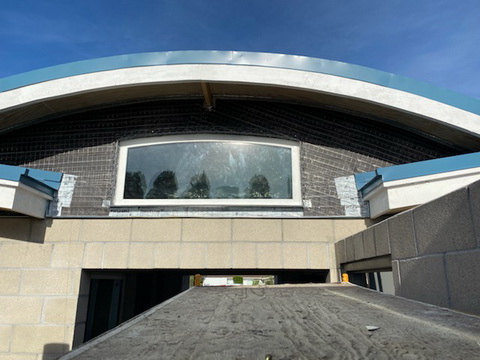

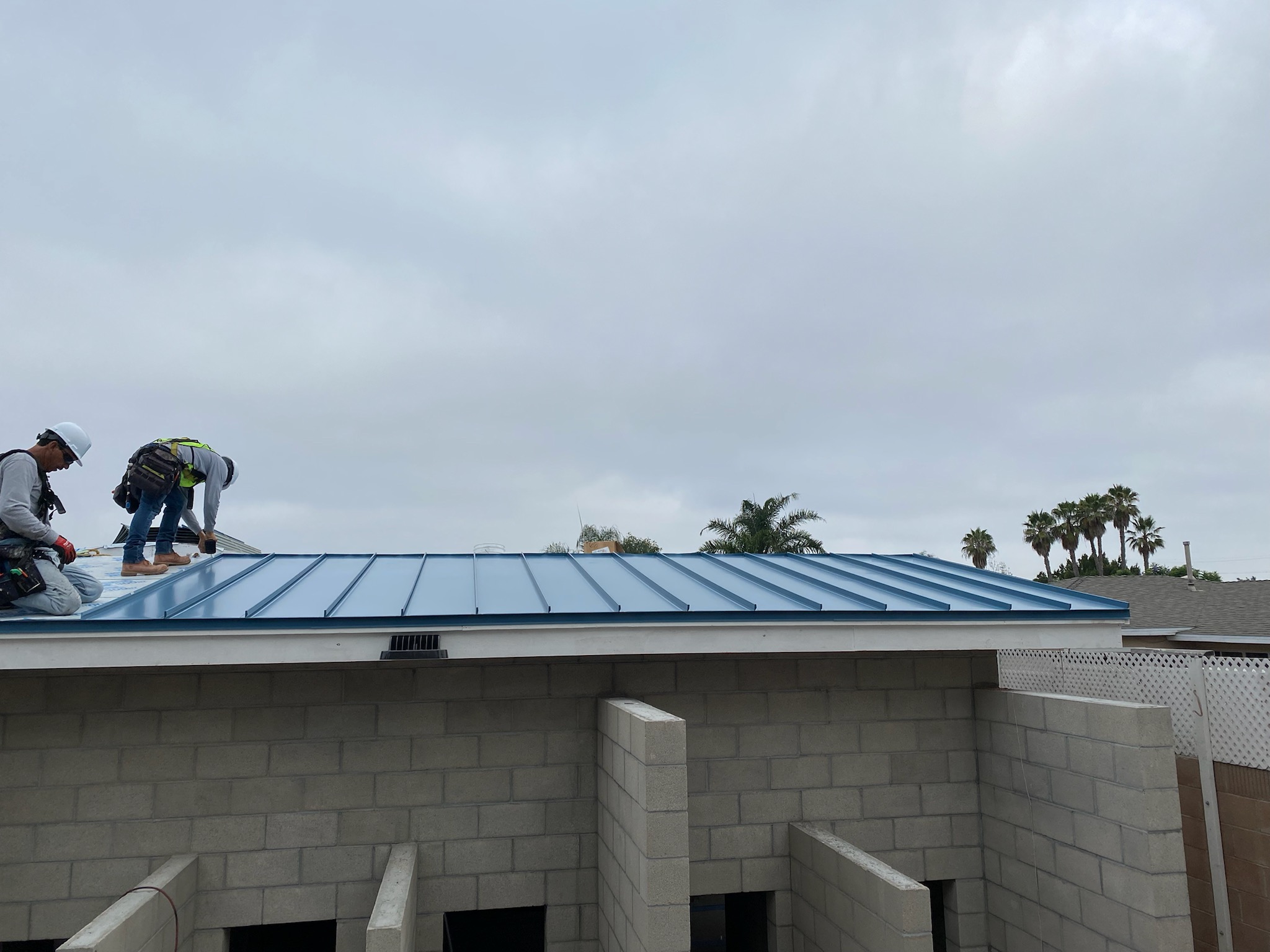

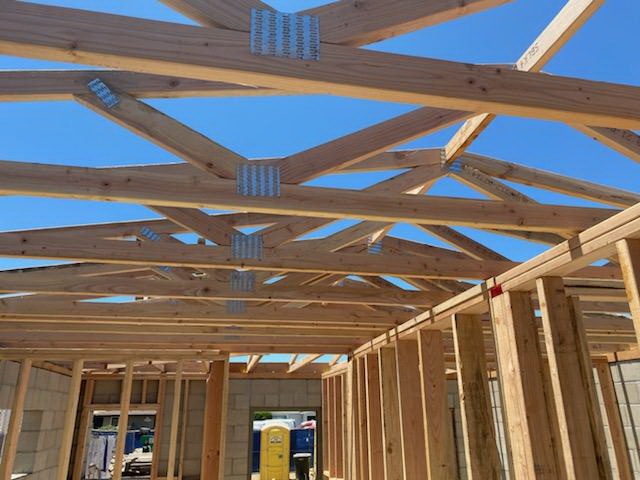

Roof installed

August 29, 2022

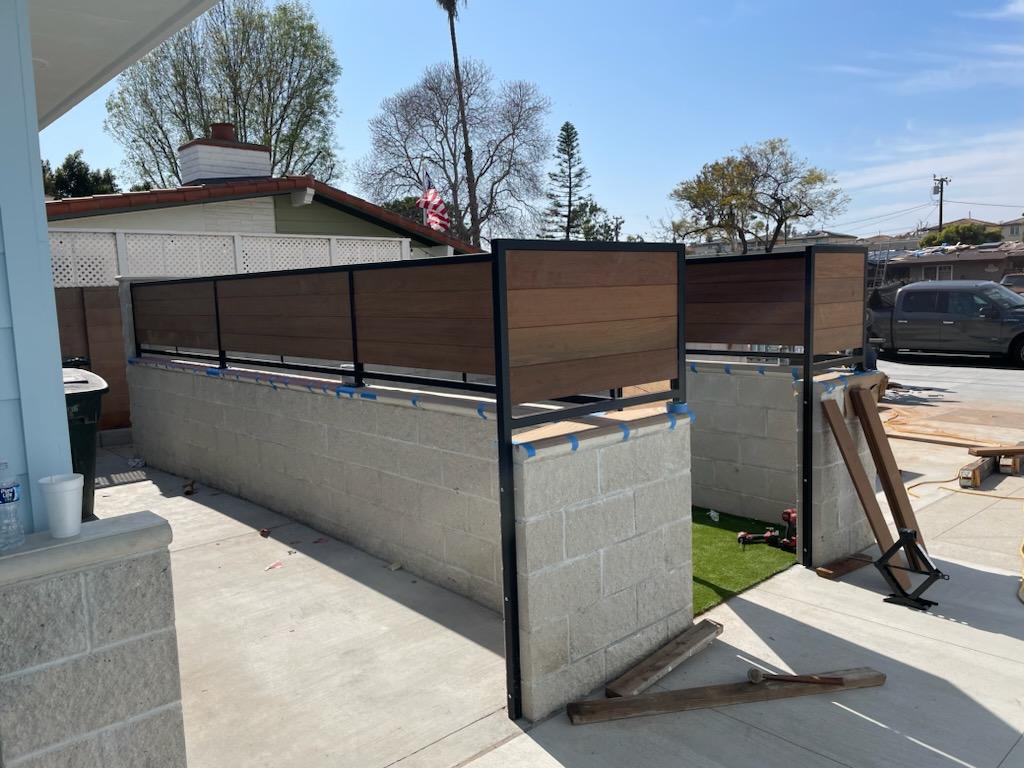

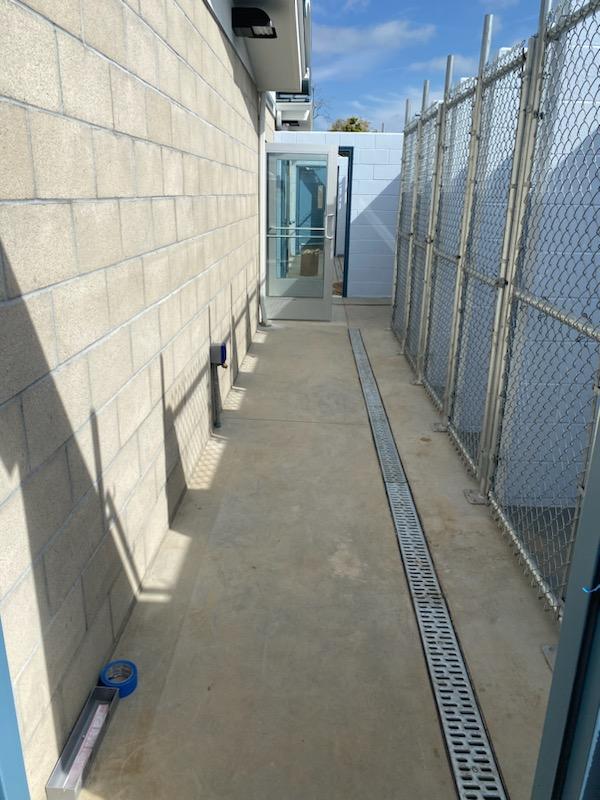

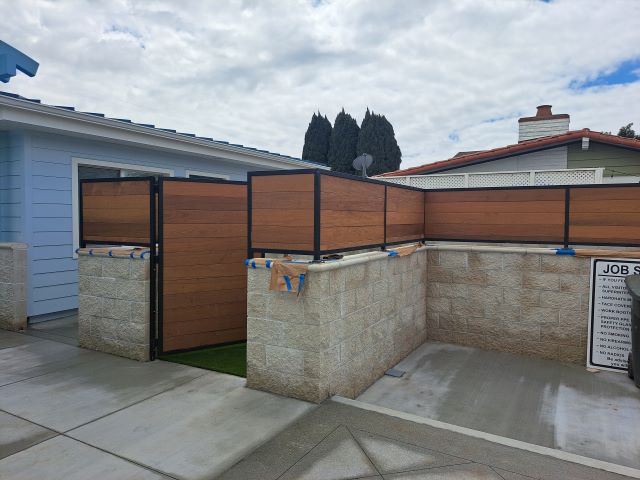

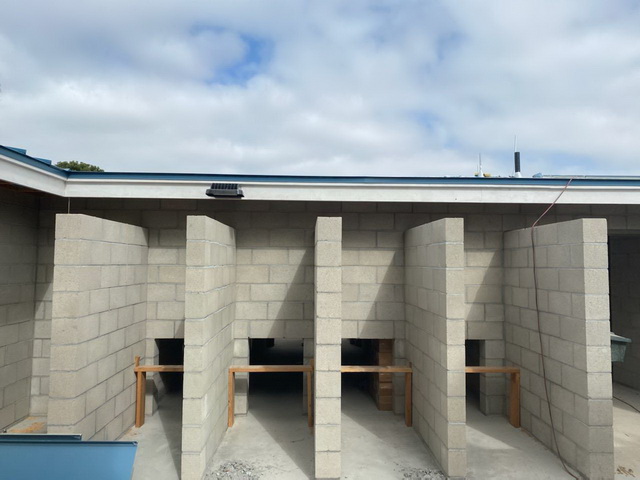

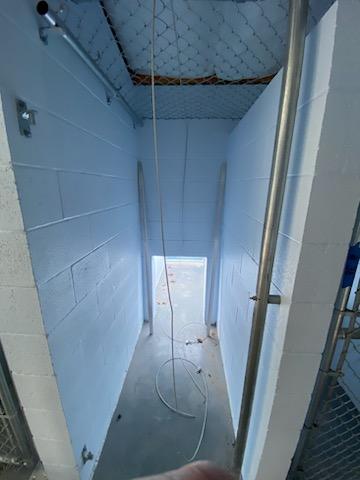

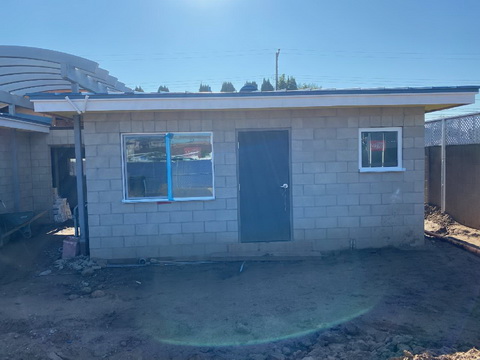

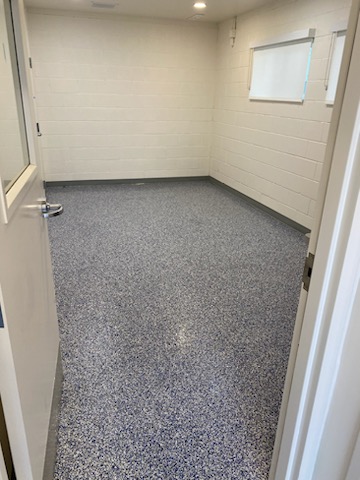

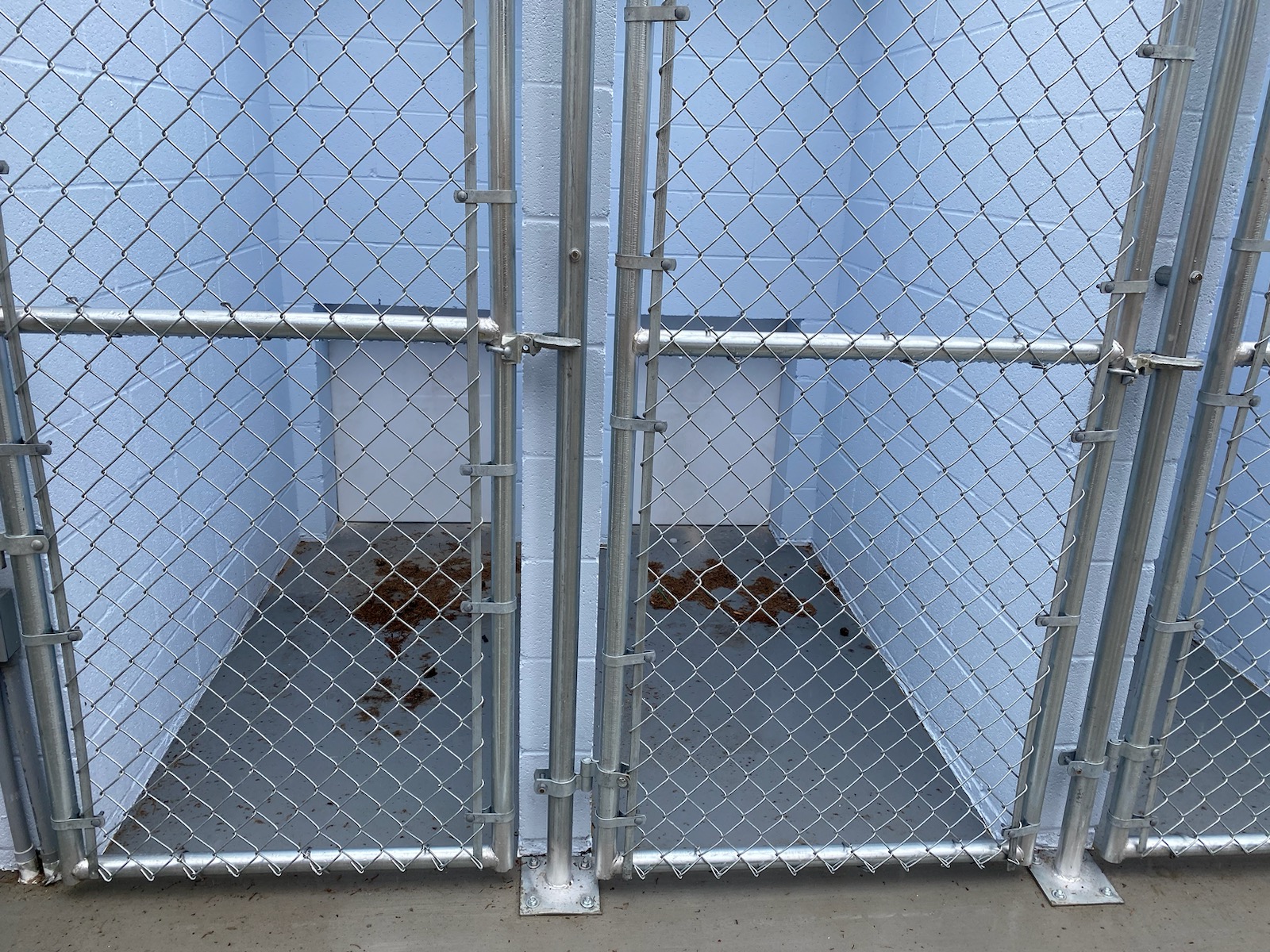

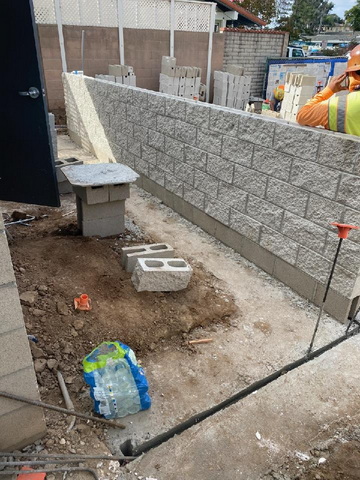

Kennel walls

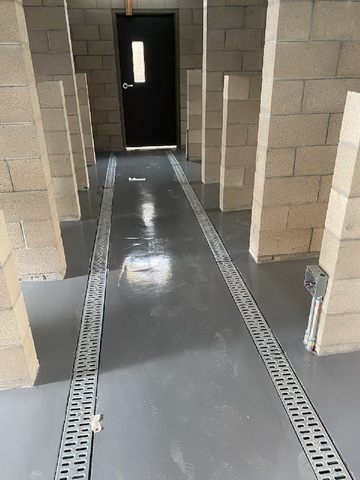

September 21, 2022

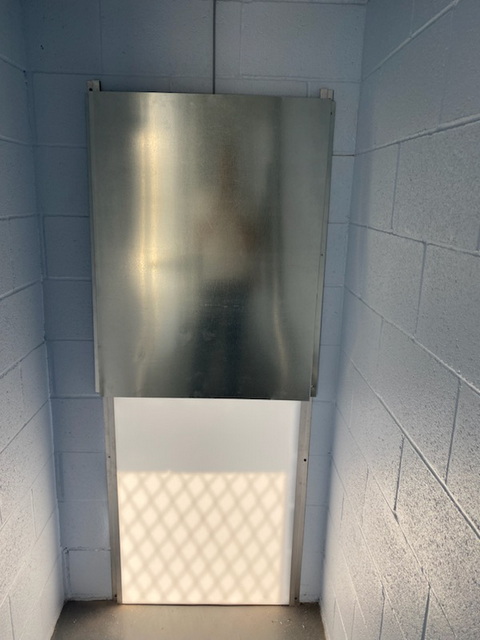

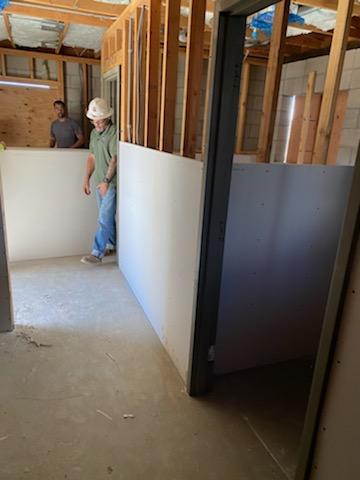

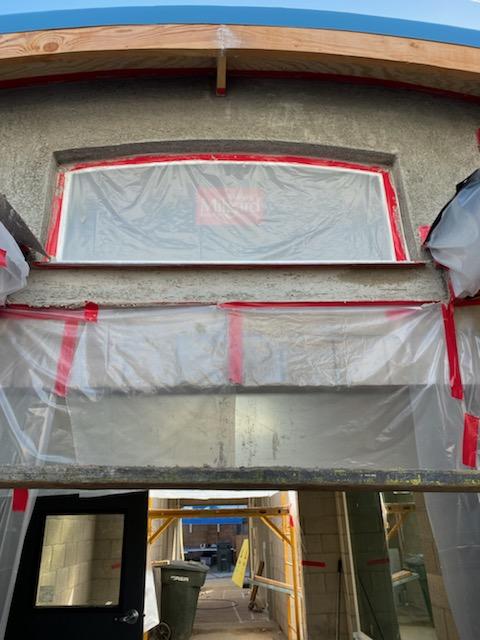

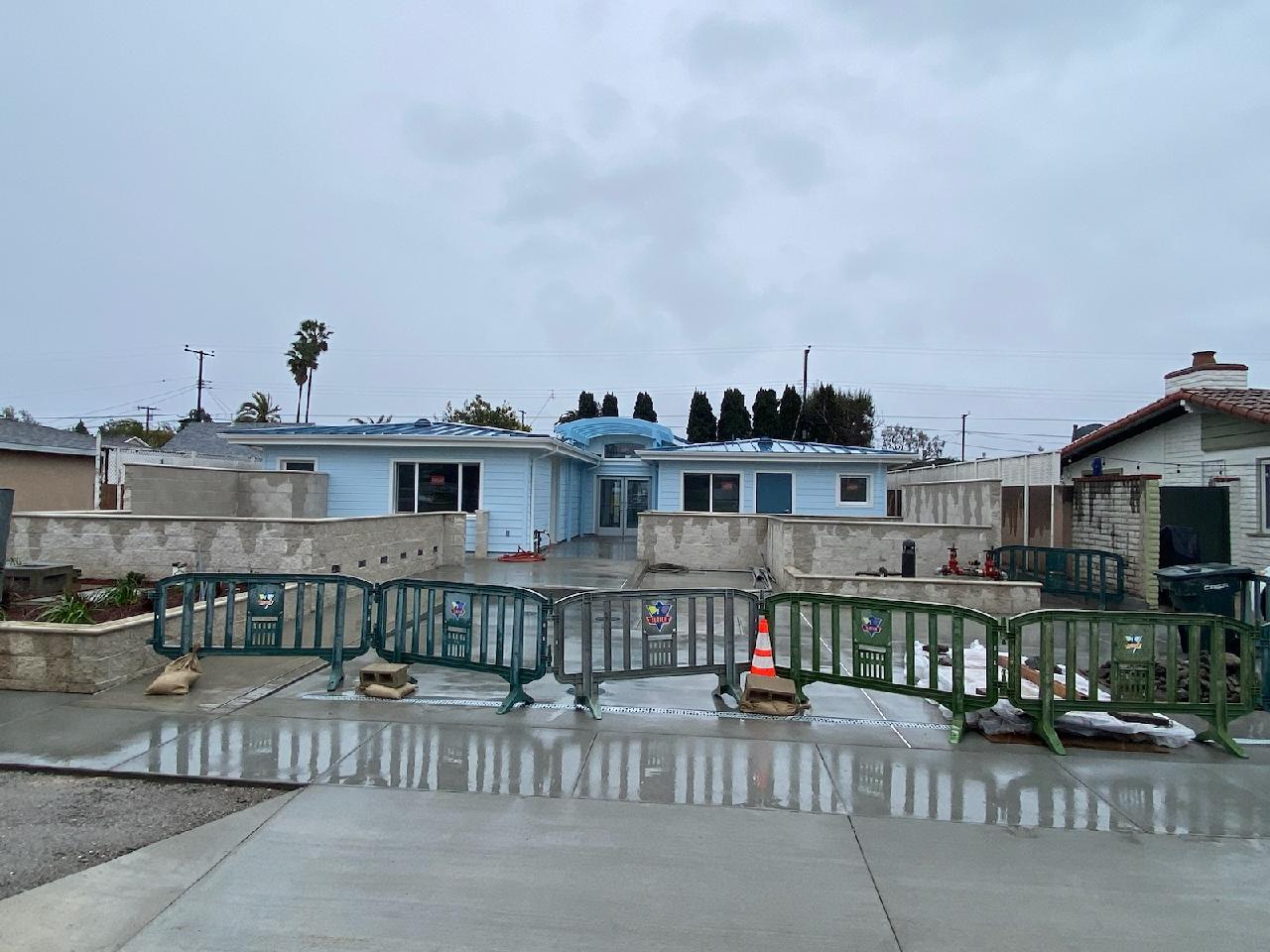

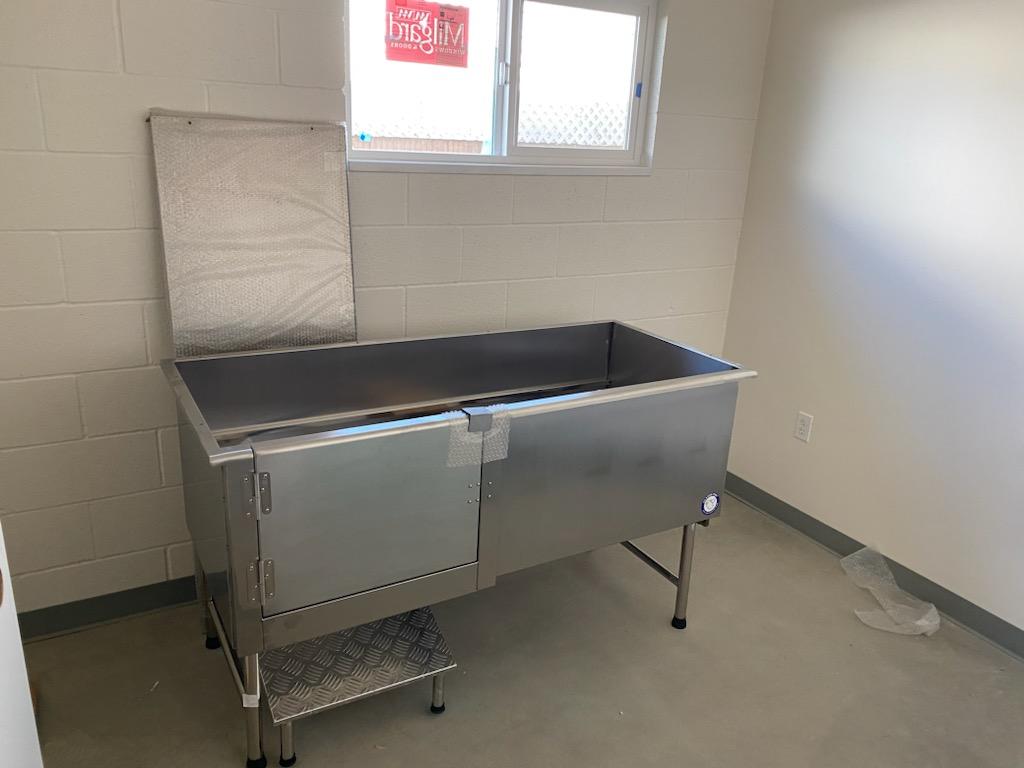

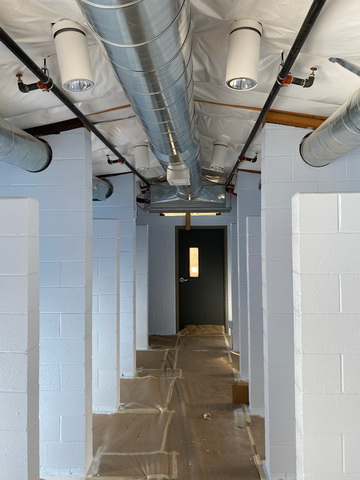

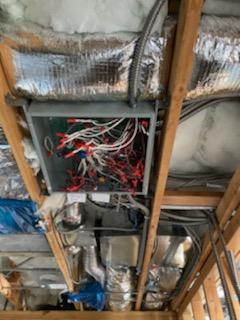

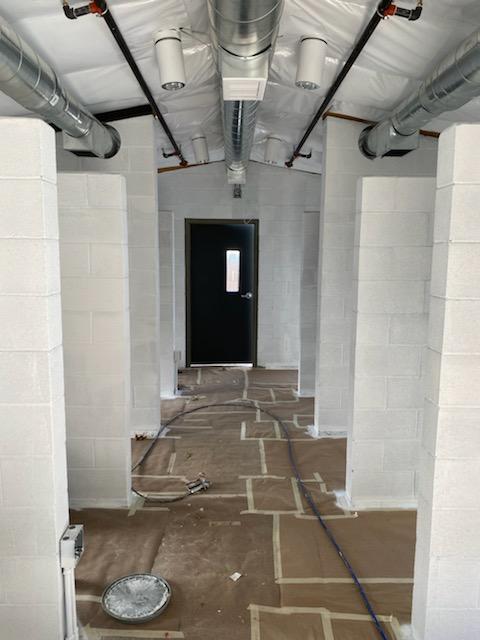

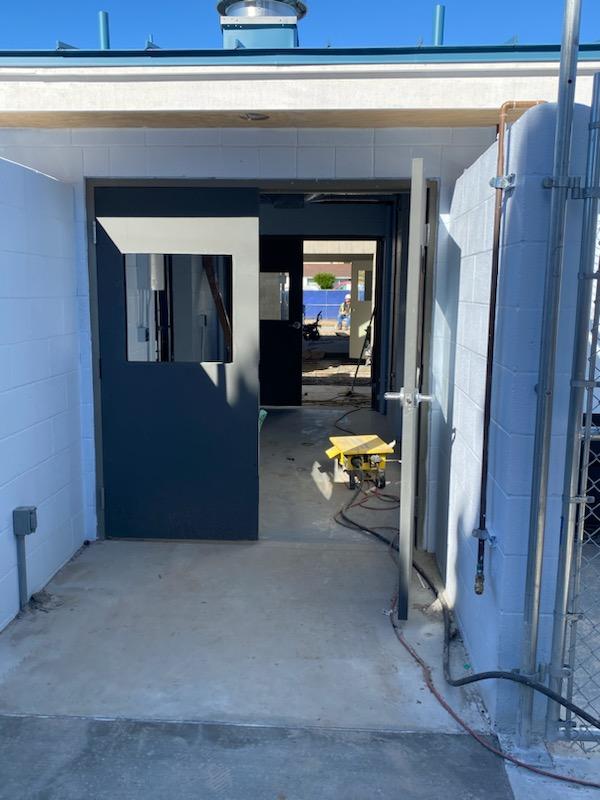

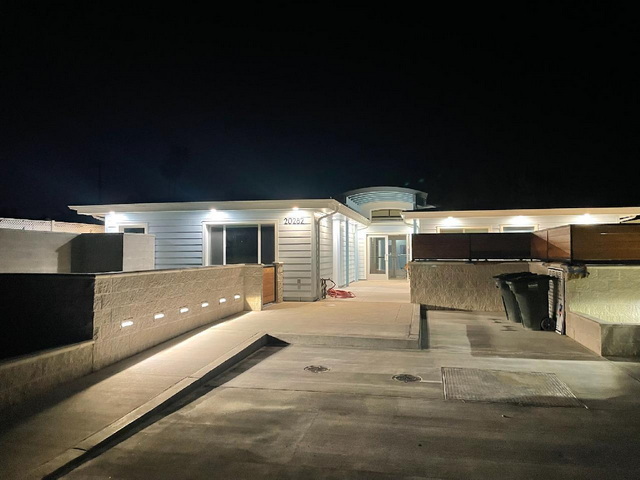

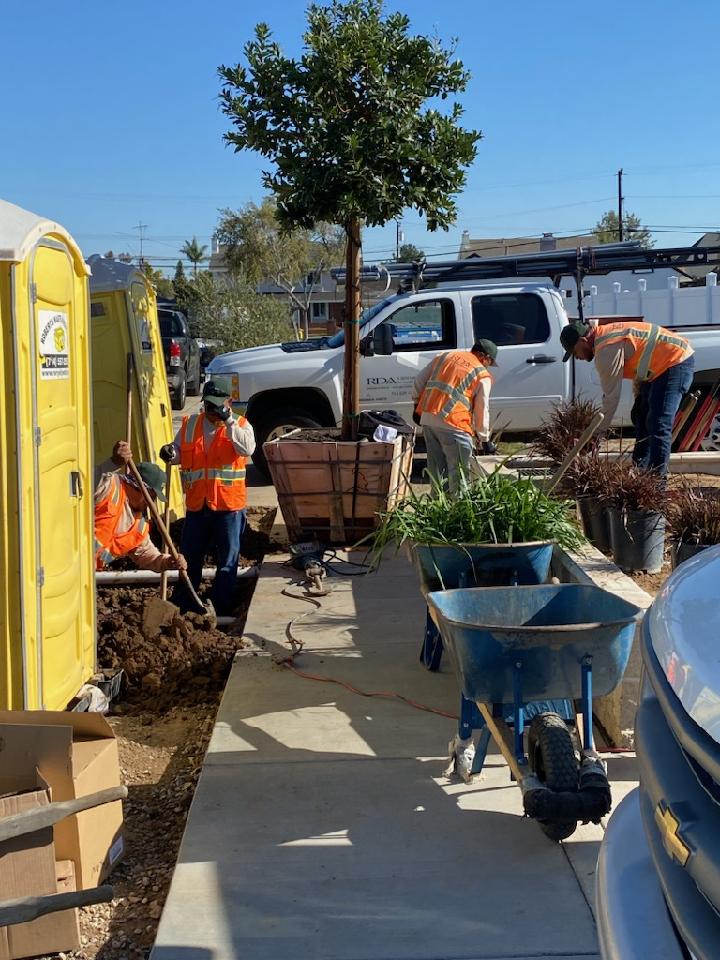

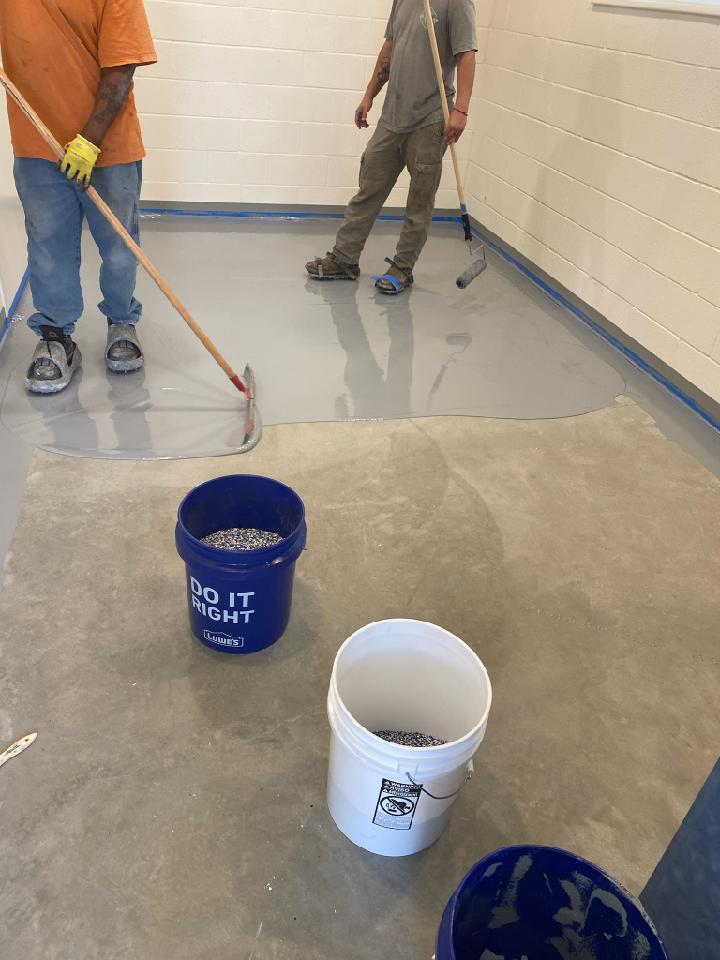

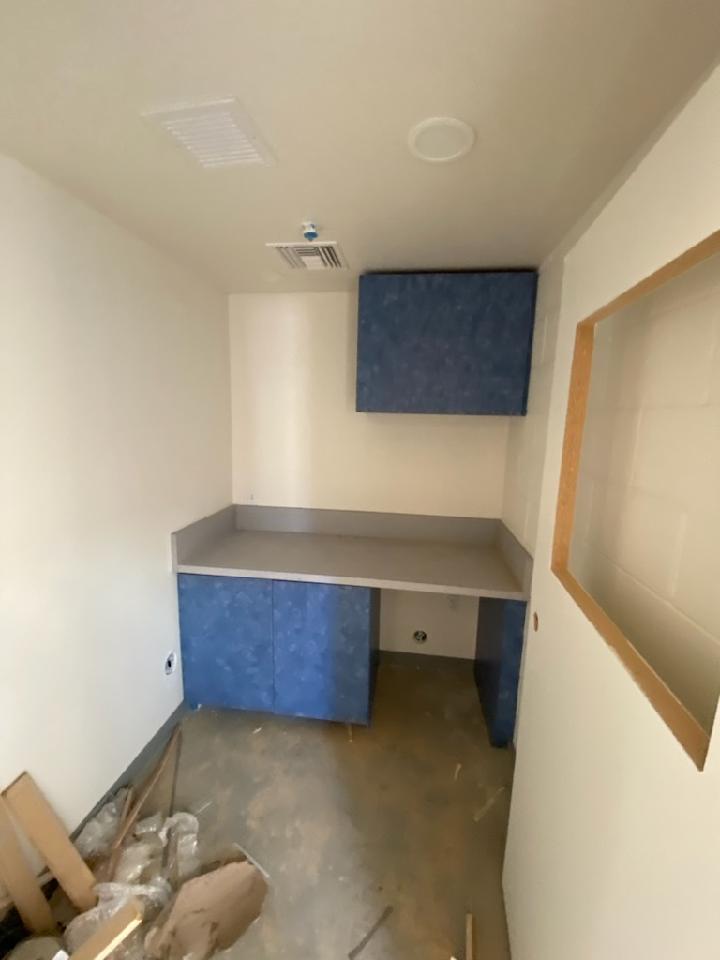

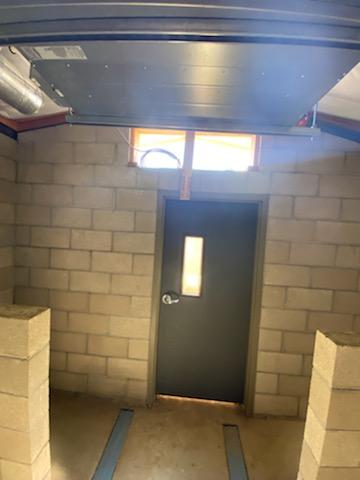

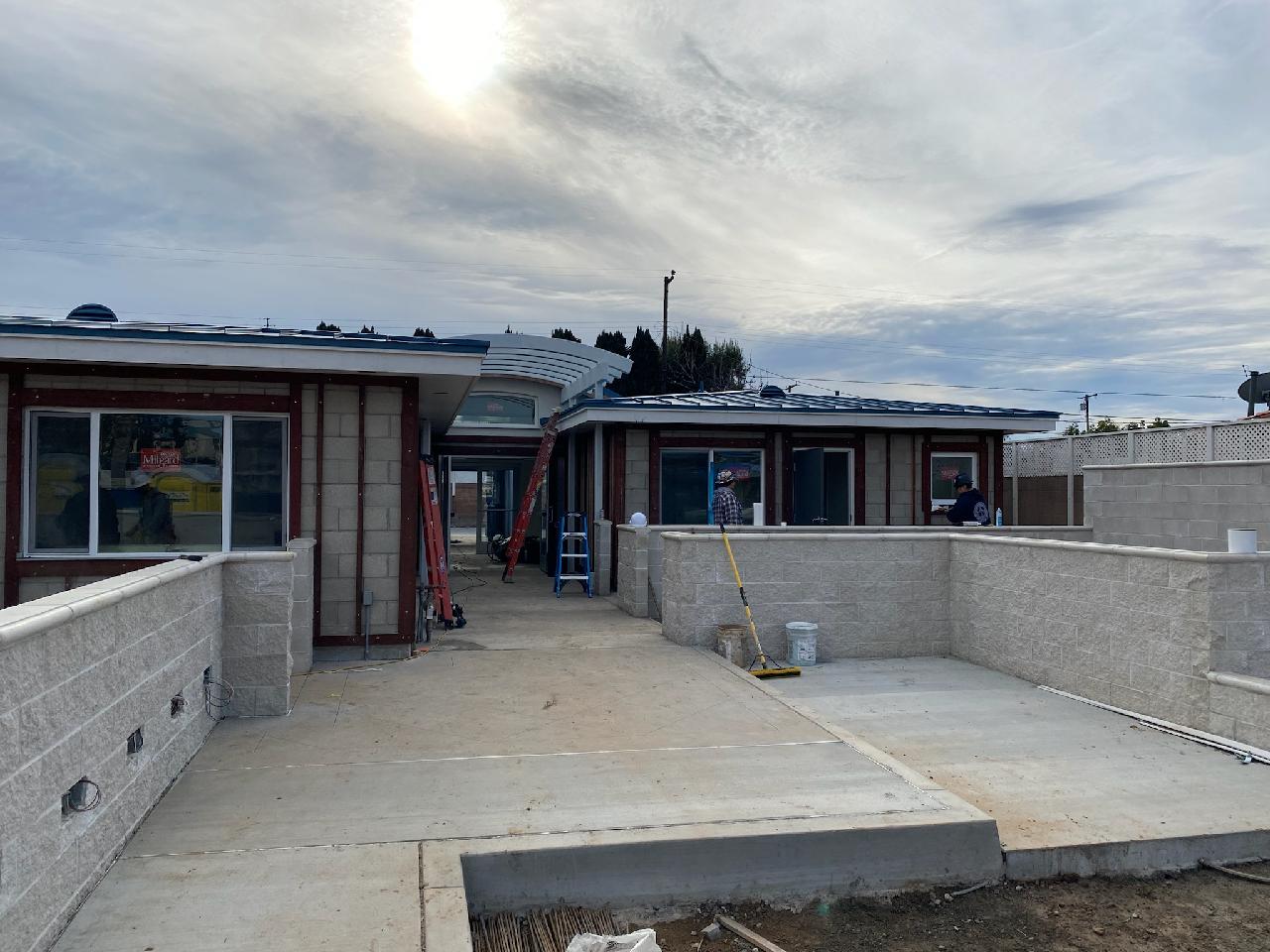

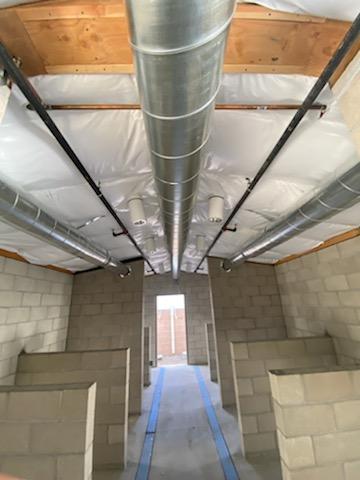

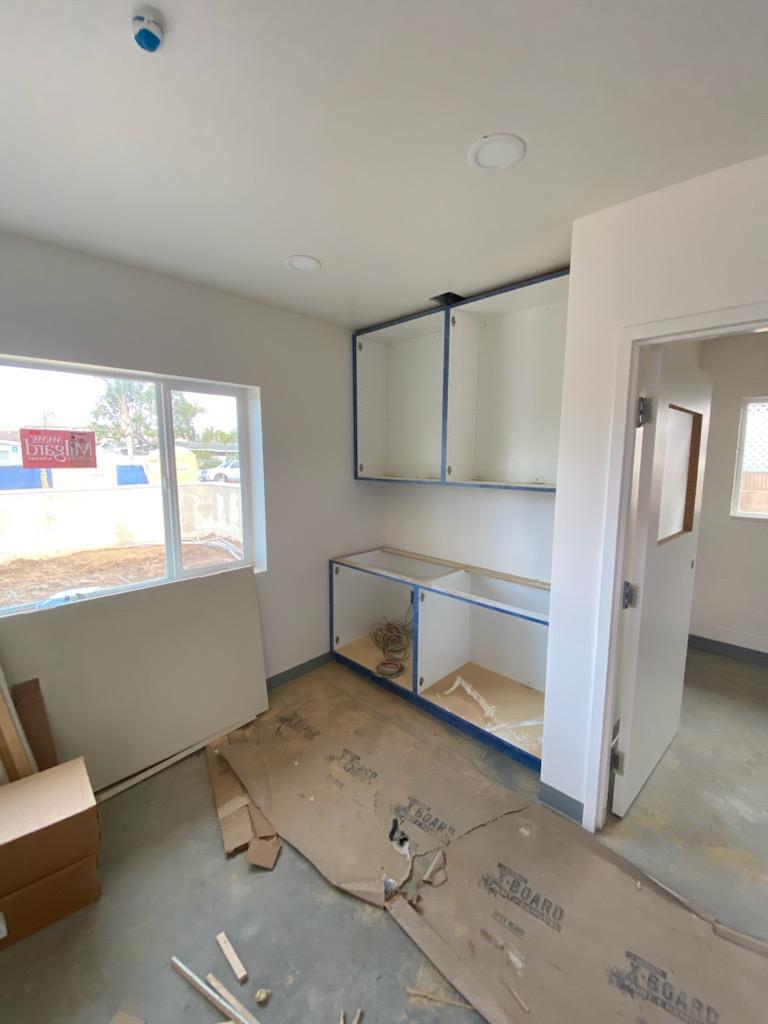

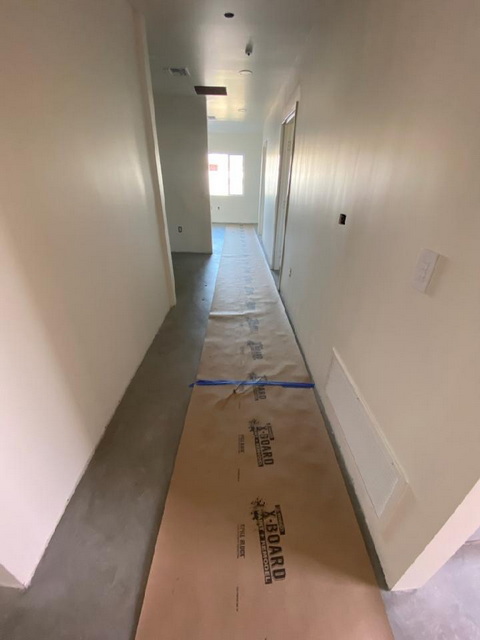

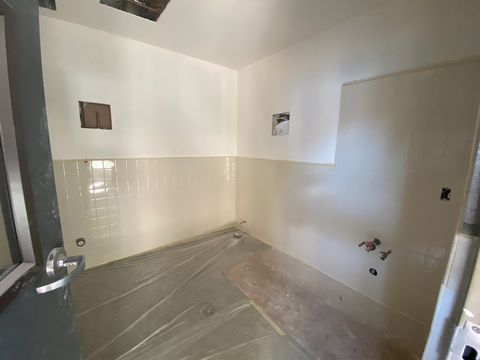

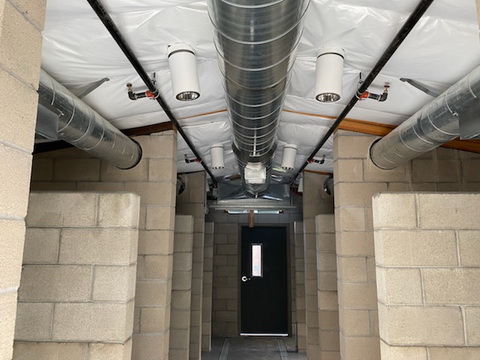

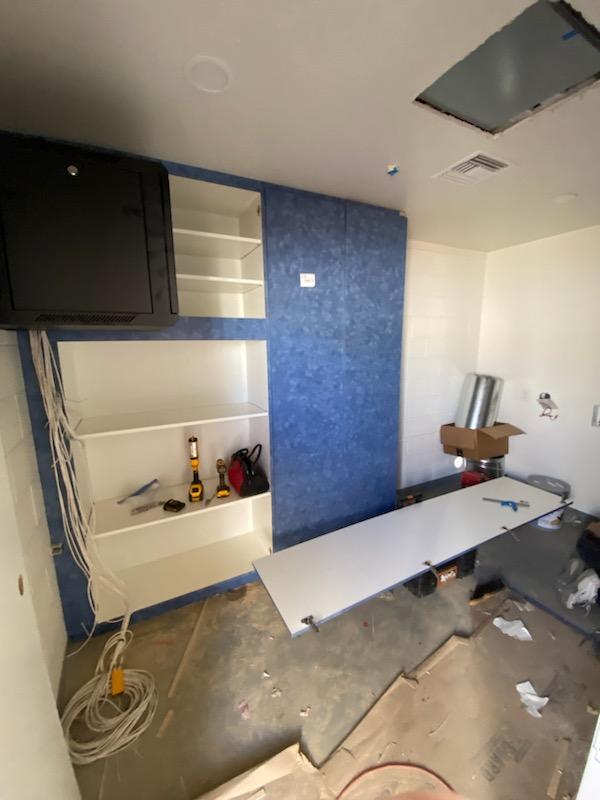

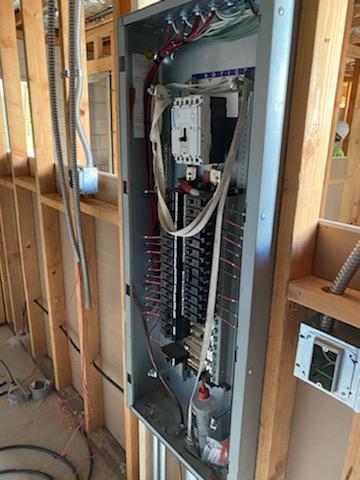

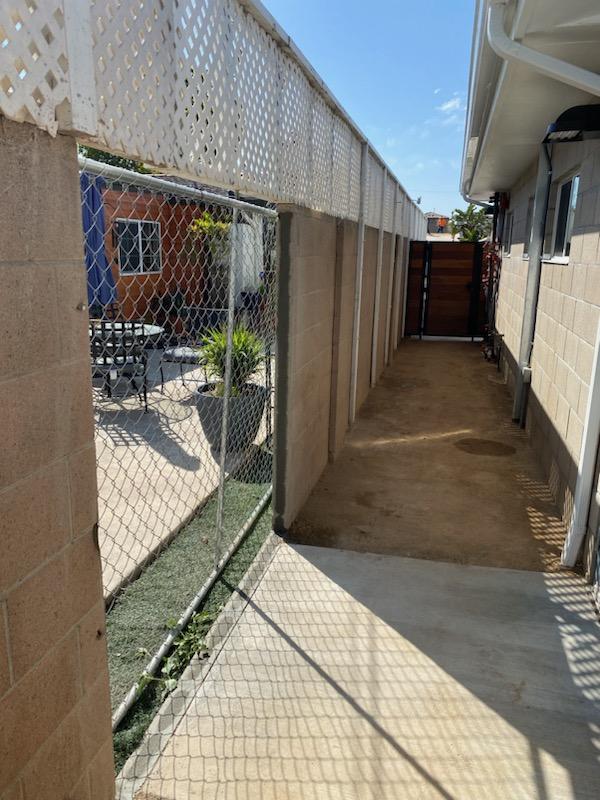

A good day of insulation, light fixtures, doors, eves.

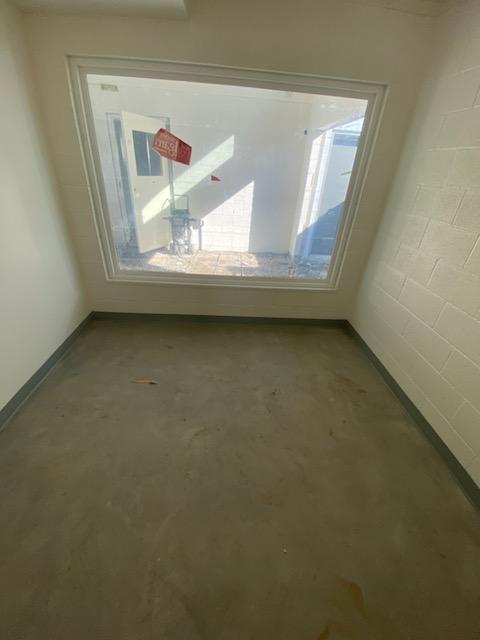

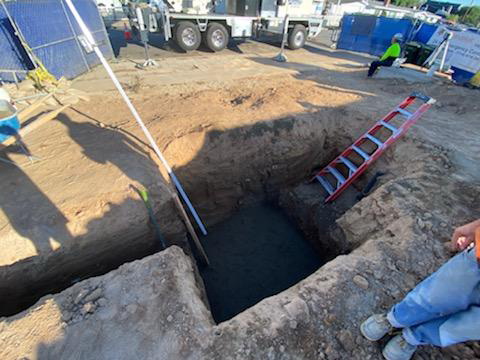

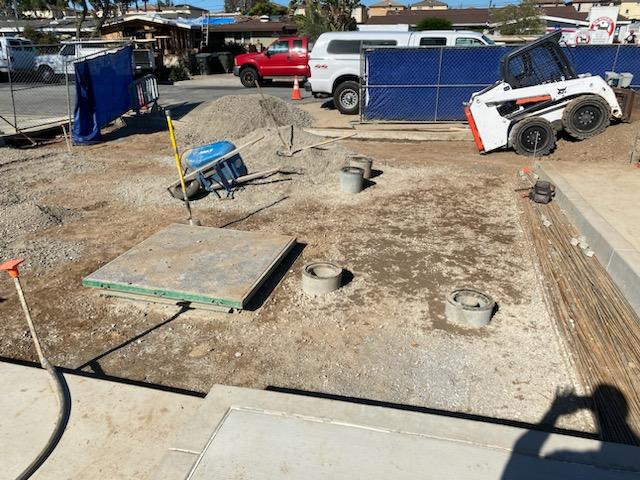

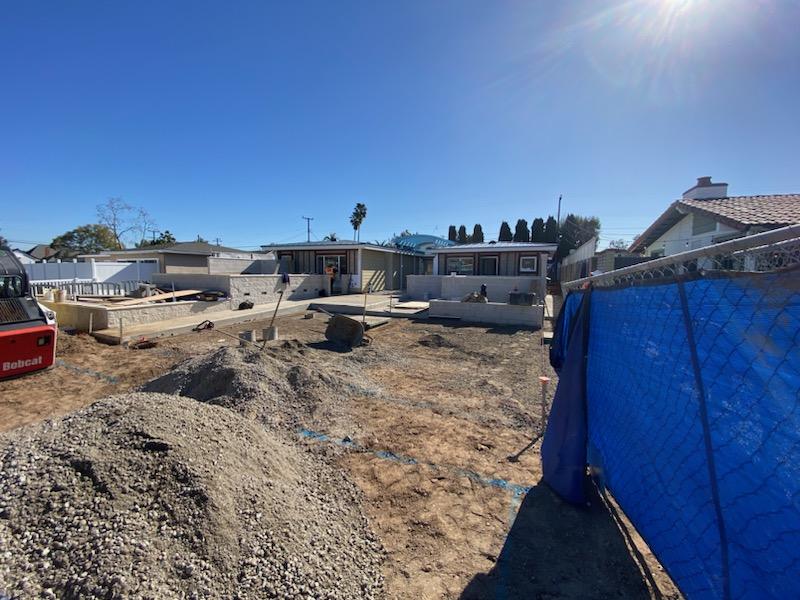

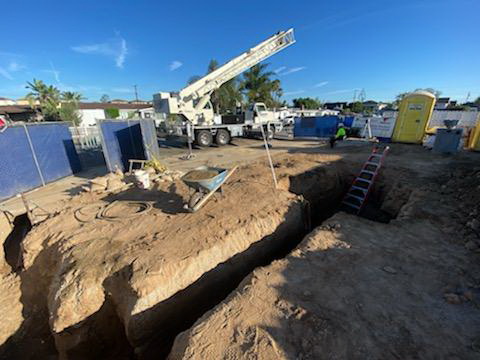

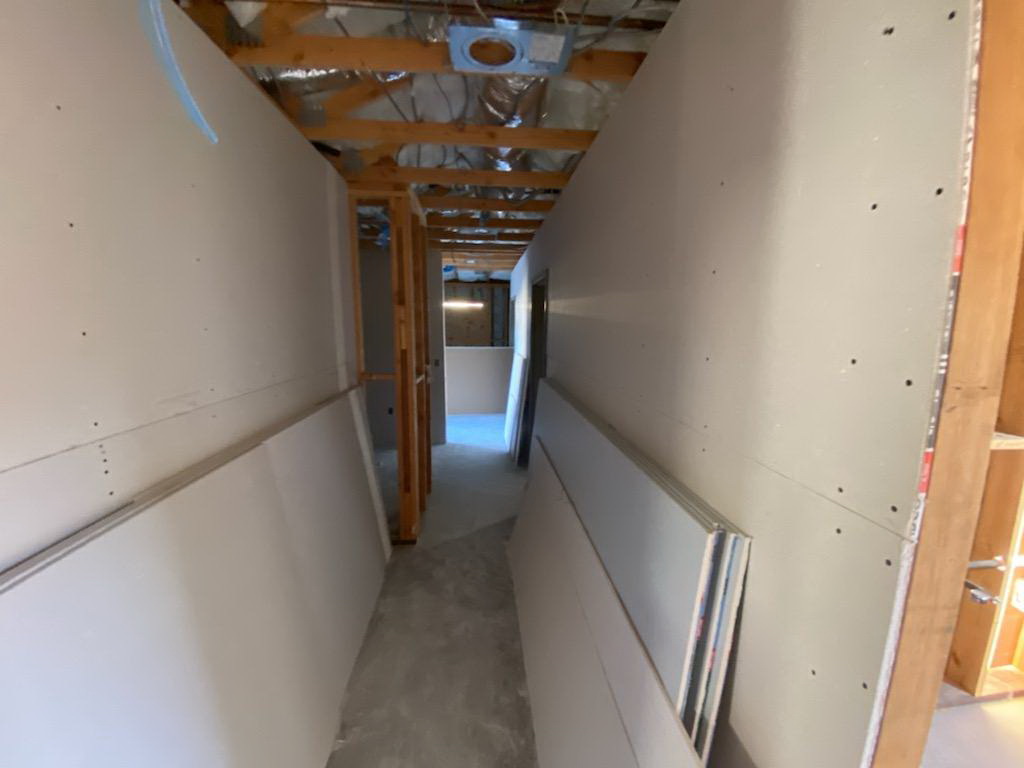

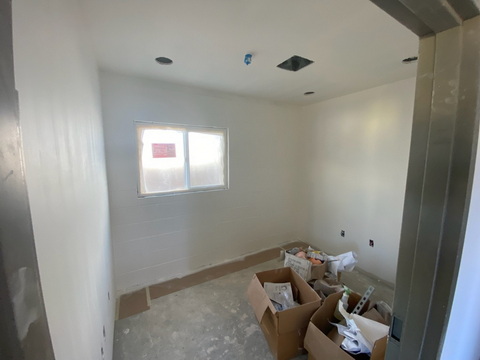

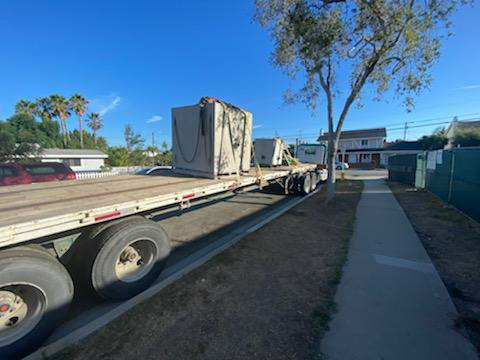

September 23,  2022

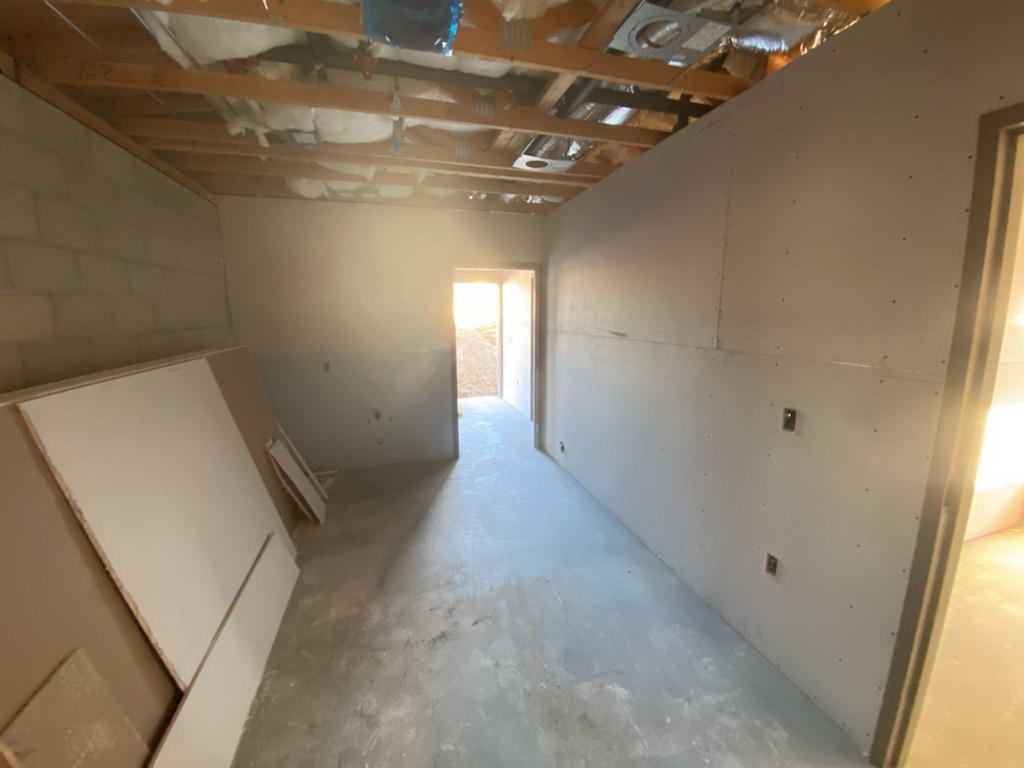

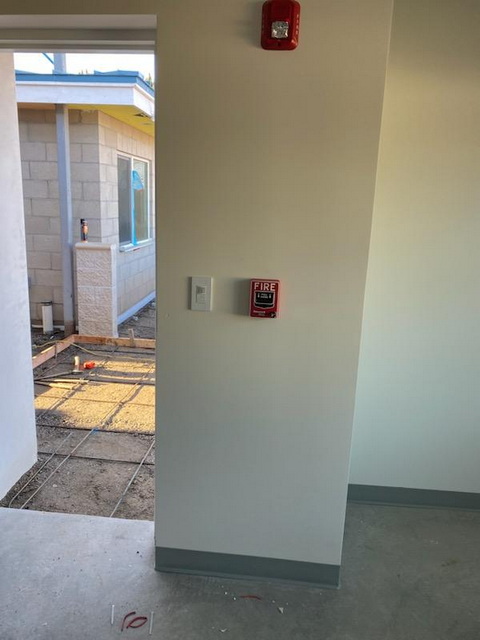

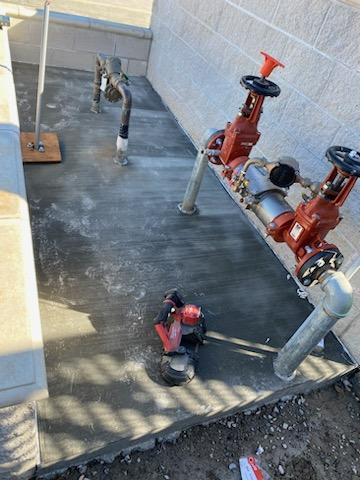

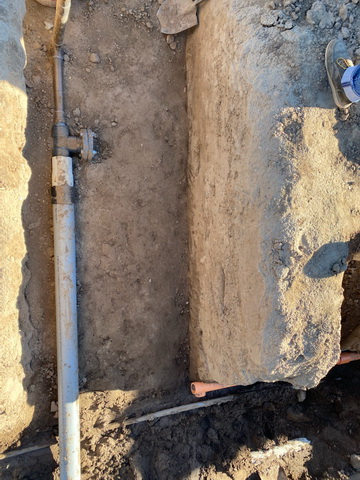

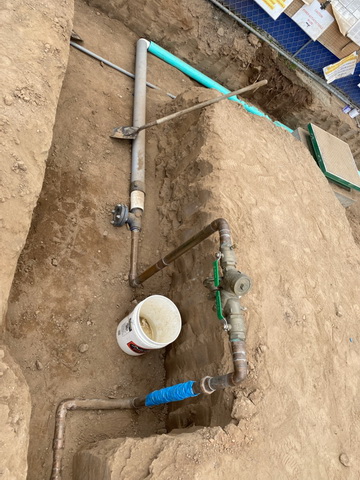

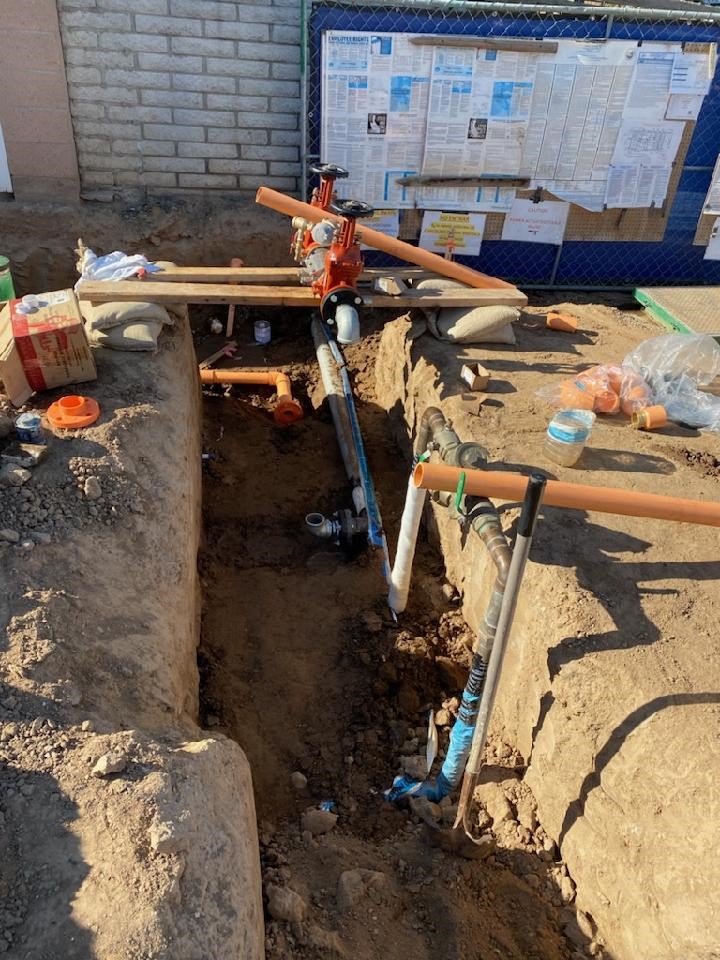

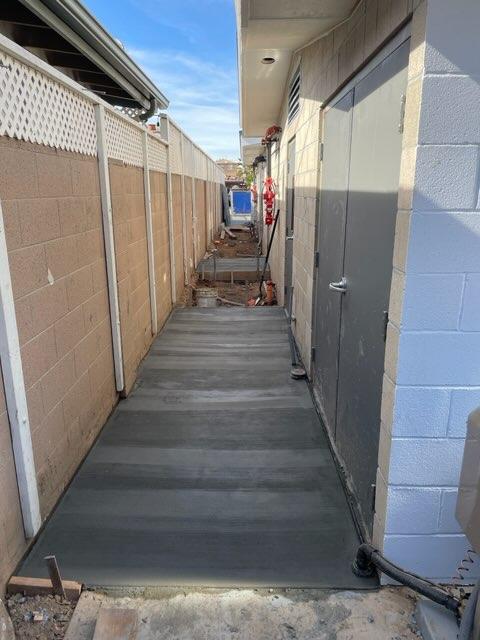

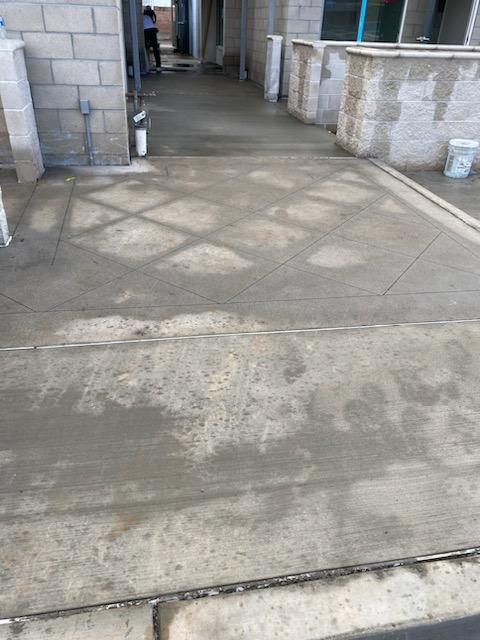

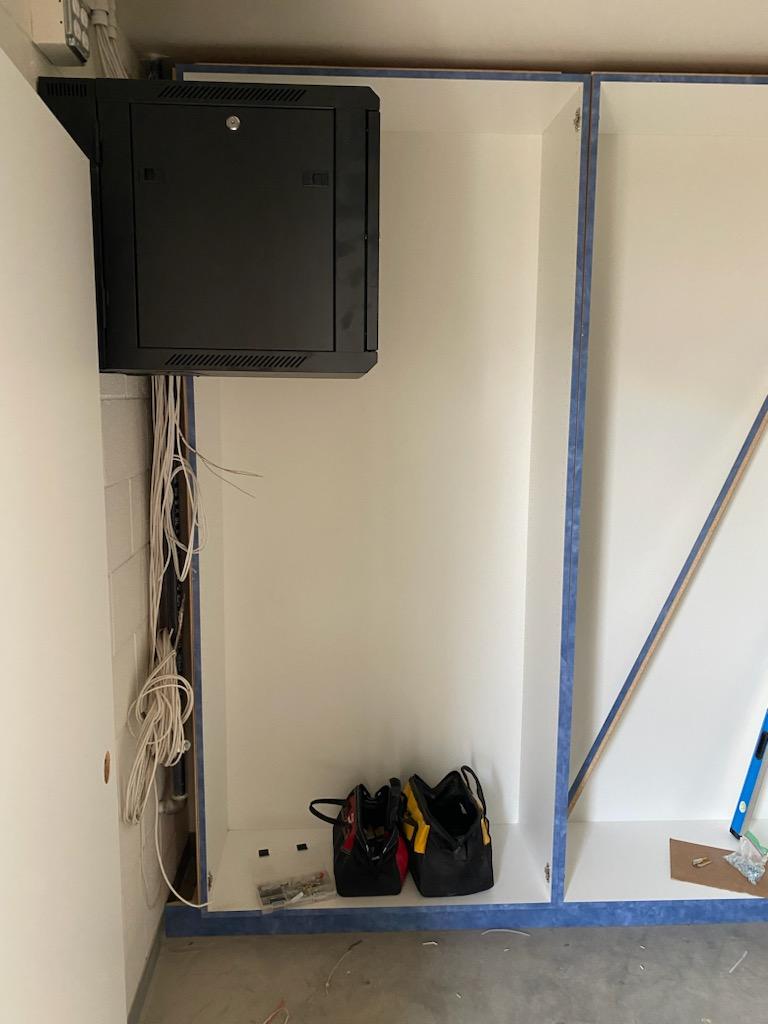

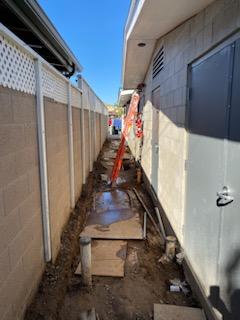

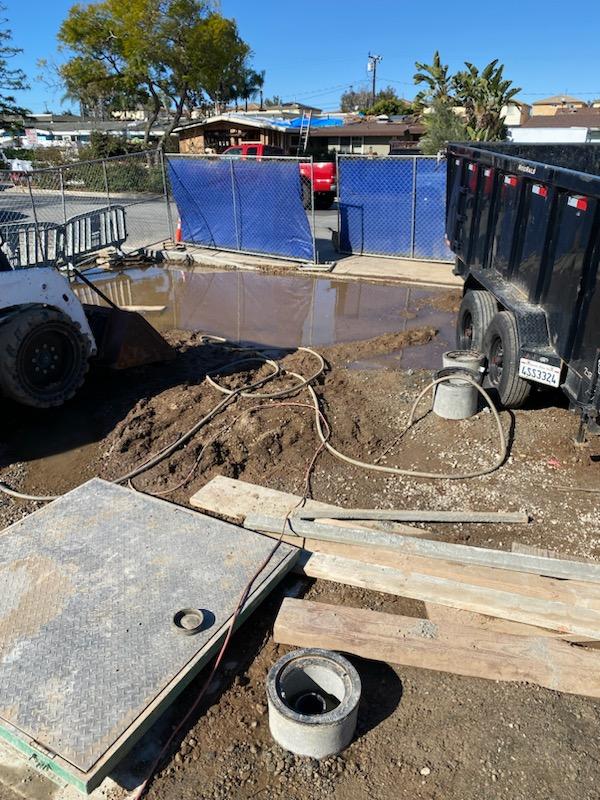

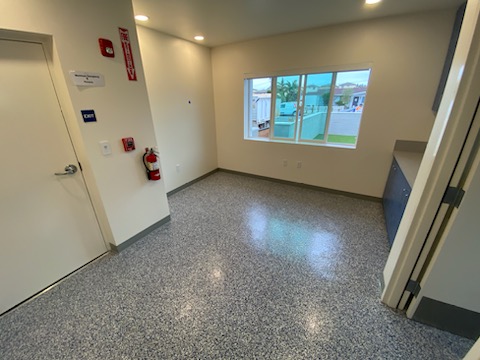

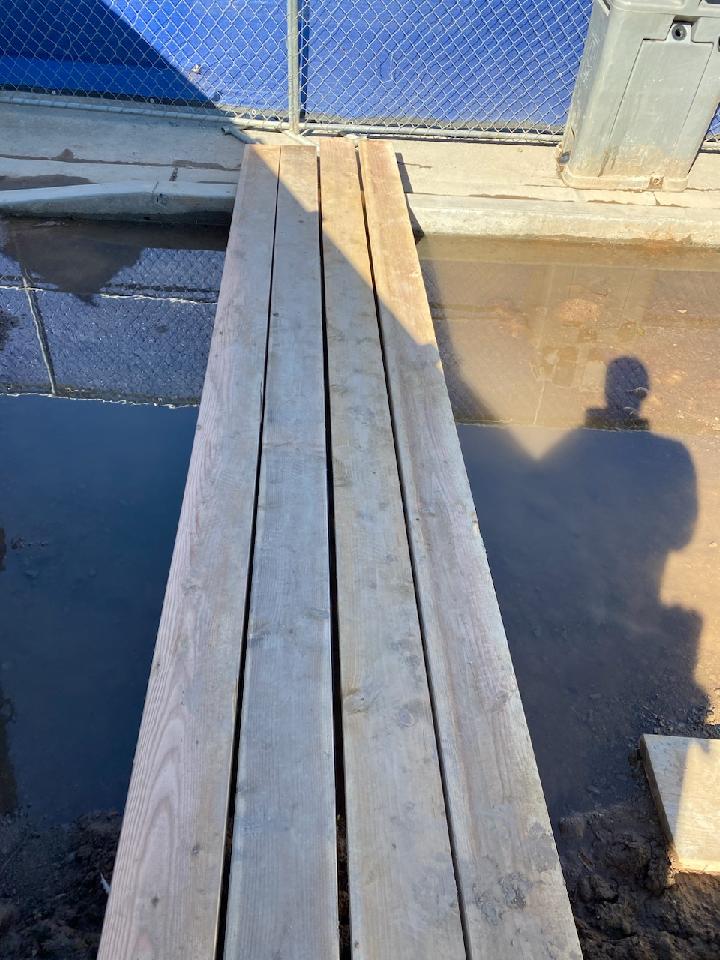

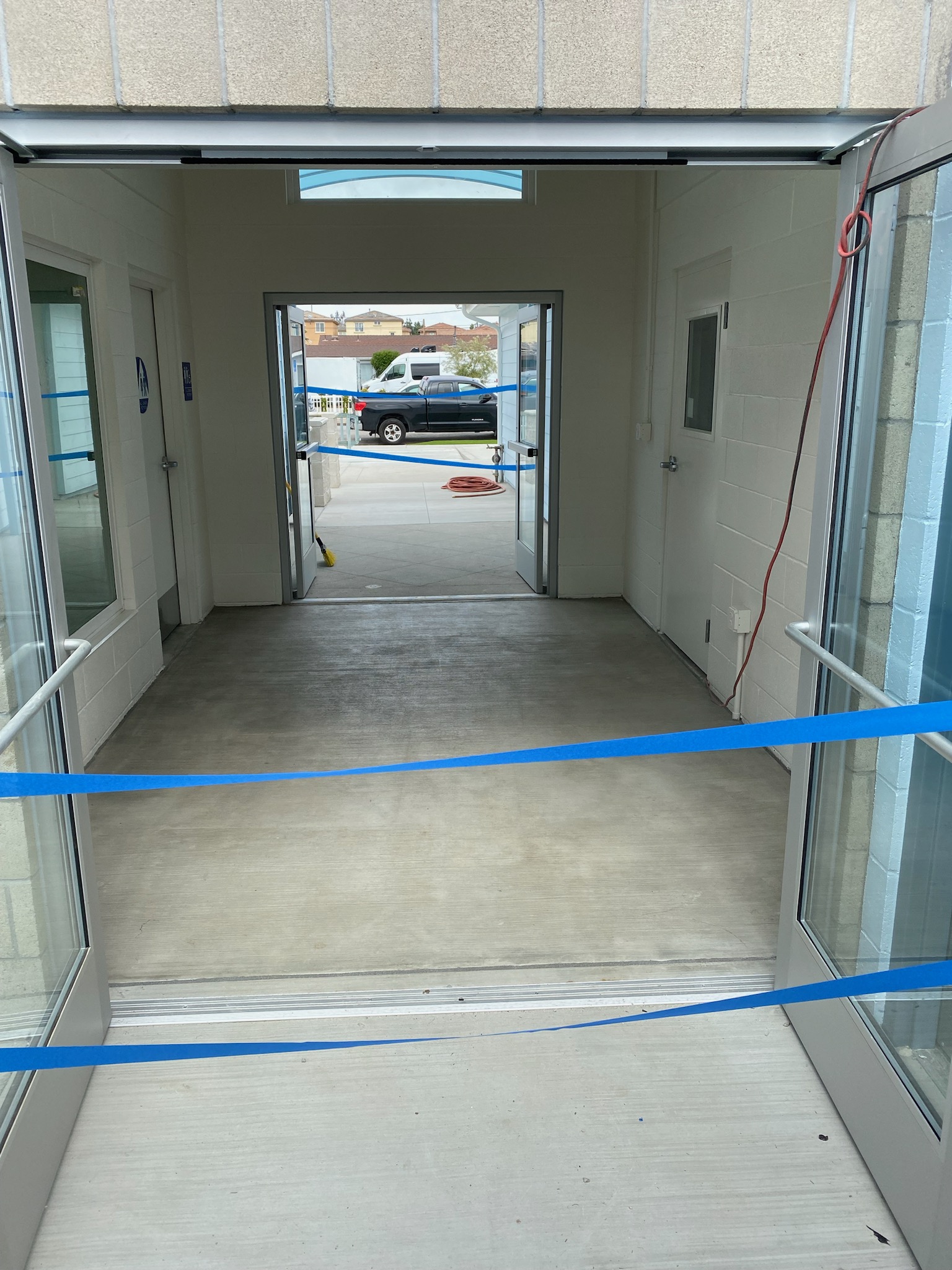

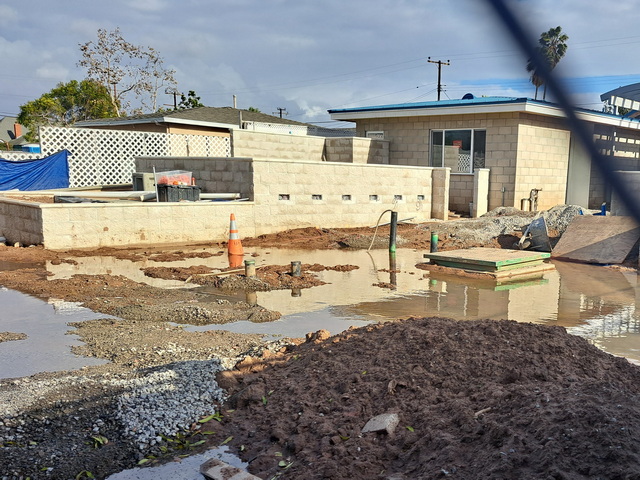

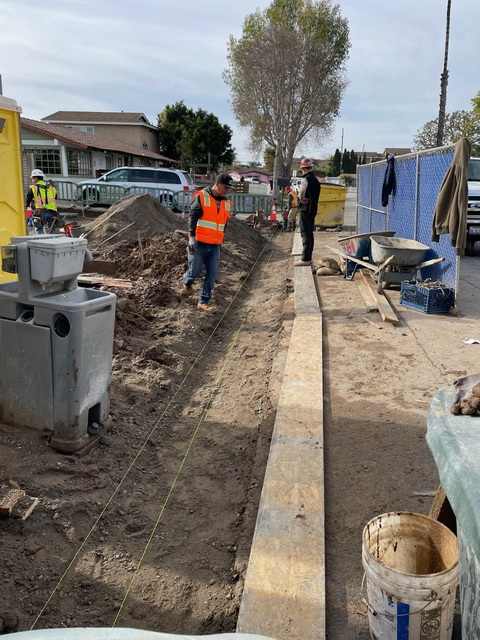

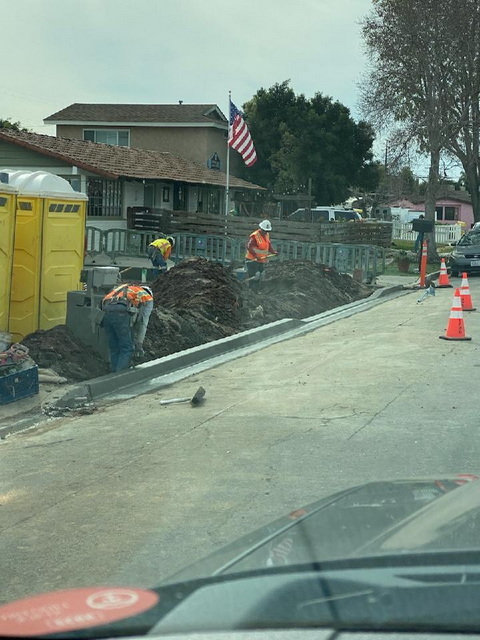

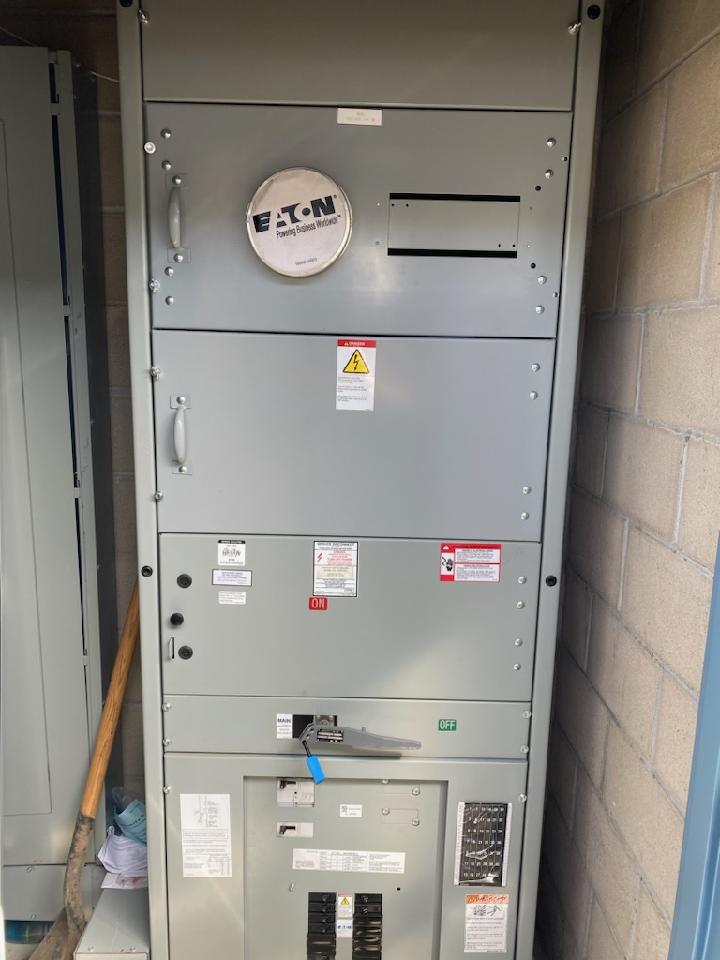

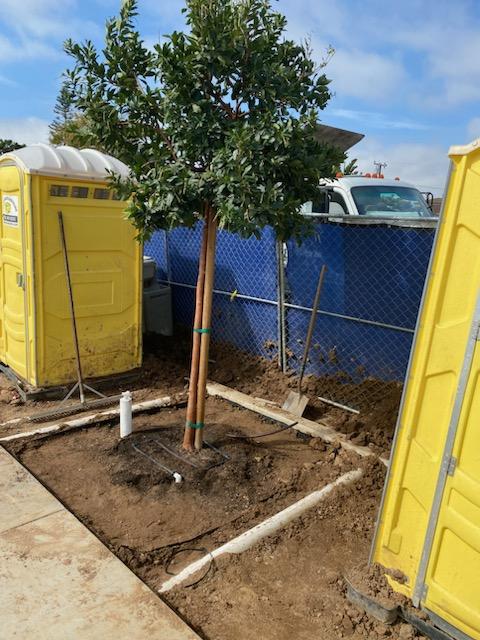

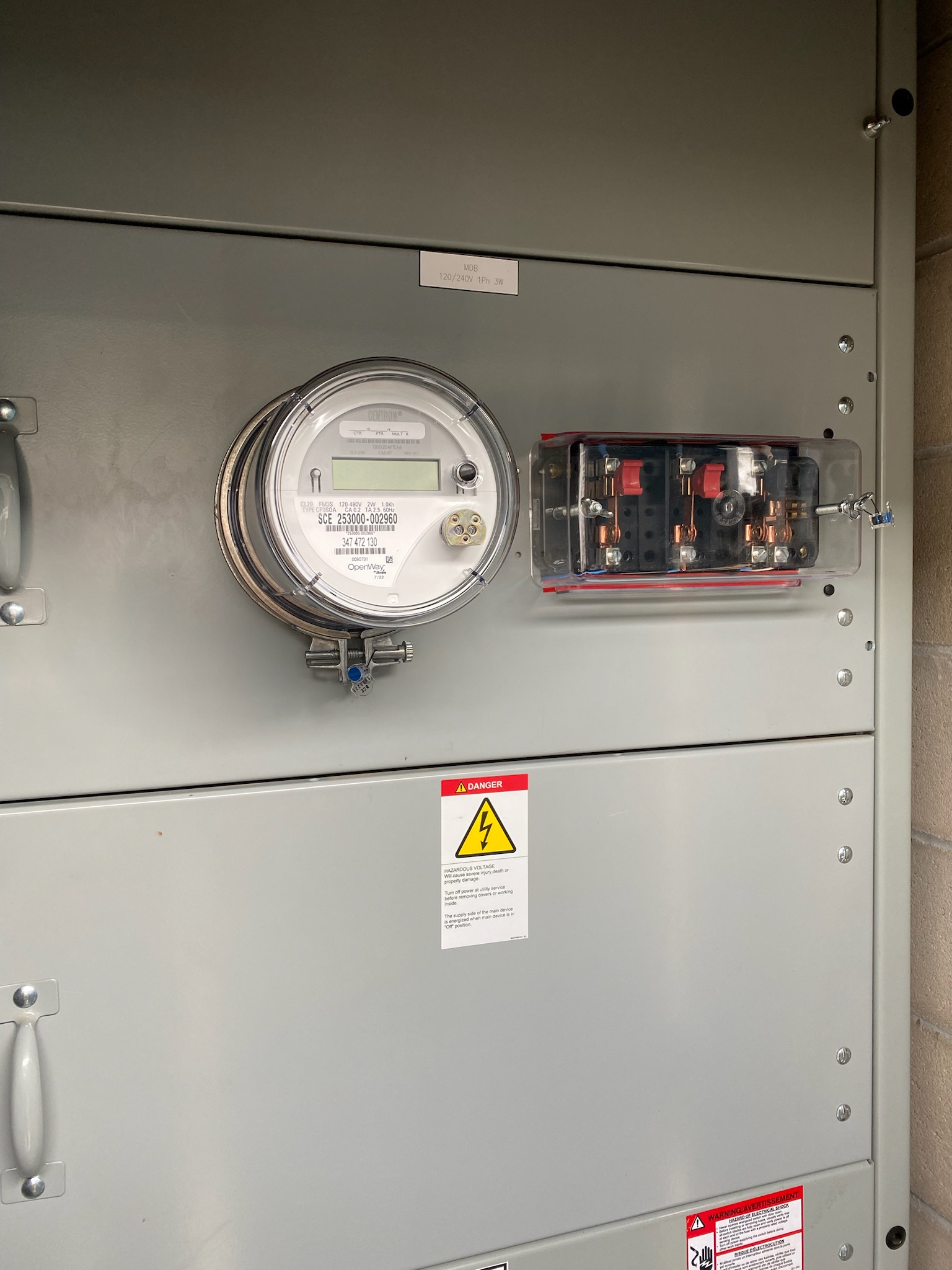

Front yard dig for run off water drain box, fire sprinkler line, backflow move, one side drywall complete pending fire sprinkler inspection, more doors.
